The floor is the easy part.
The slab under it,
and staying open, are not.

Commercial flooring is decided by two things nobody puts in the brochure: what the concrete slab underneath is doing, and how the building keeps operating while the floor is replaced. Get those right and the material choice is comparatively simple. We install commercial flooring across Miami-Dade, Broward and Palm Beach, phased around your hours.

  • Licensed, bonded & insured · CBC1265280
  • 104 municipalities across 3 counties
  • Design-build: permitting & construction in-house

Miami-Dade · Broward & Palm Beach Counties

Scroll

Recent projects

Commercial flooring, part by part

Twelve images. Six are genuine Elbaz flooring photographs from our library, all residential interiors, and six are illustrations drawn for this guide. Tap any image to see it larger - each caption says which it is.

01

PHOTOGRAPH, residential: herringbone across a large open span.

02

ILLUSTRATION: moisture-testing a concrete slab.

03

PHOTOGRAPH, residential: wide plank through a large open interior.

04

ILLUSTRATION: self-levelling compound over a prepared subfloor.

05

PHOTOGRAPH, residential: a long uninterrupted run of wide plank.

06

ILLUSTRATION: resilient plank laid along a corridor.

07

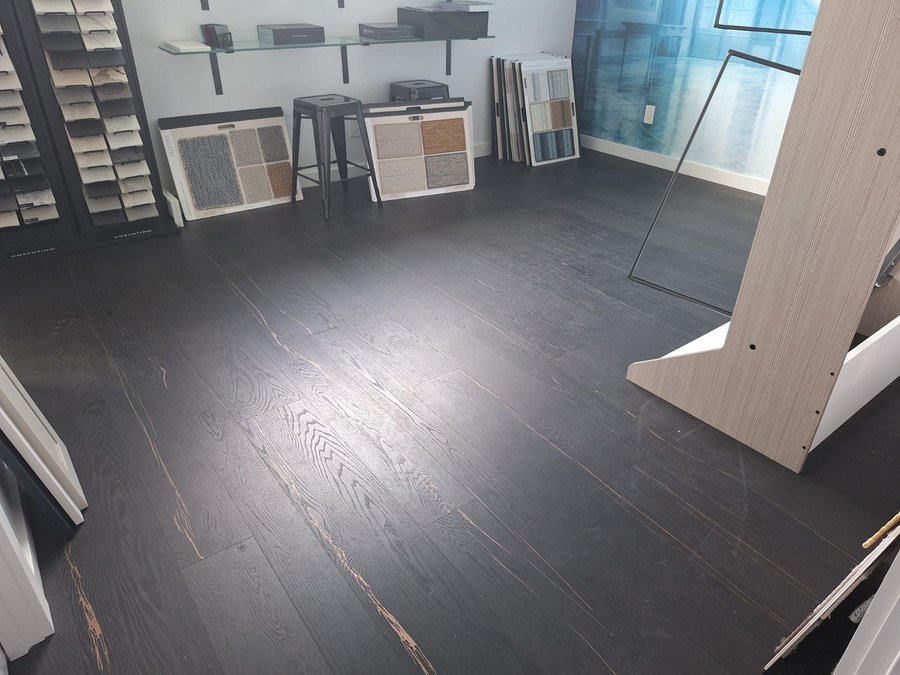

PHOTOGRAPH, residential: wide plank with sample boards on display.

08

ILLUSTRATION: carpet tile in a quarter-turn pattern.

09

PHOTOGRAPH, residential: stair treads finished to match the floor.

10

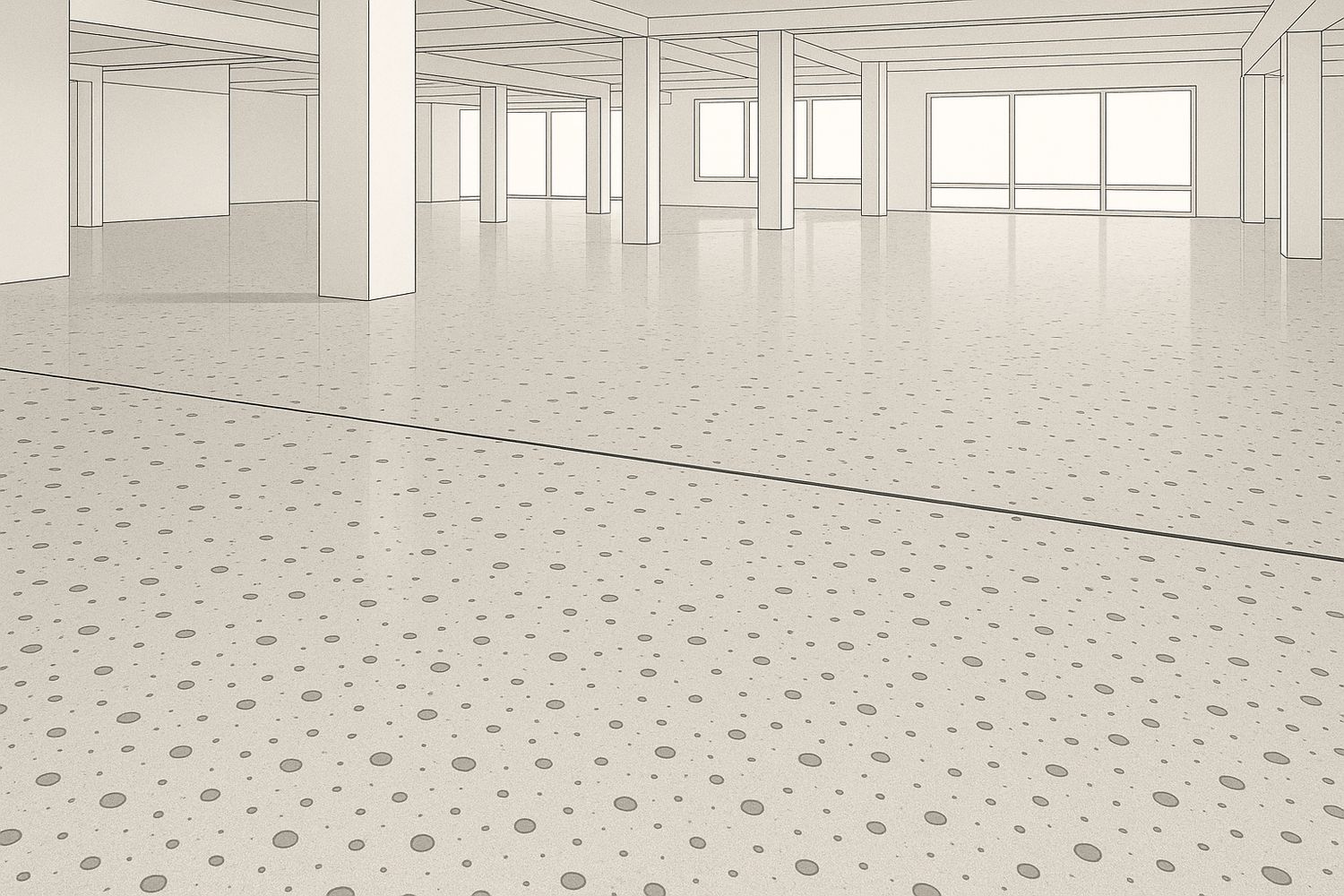

ILLUSTRATION: polished concrete with exposed aggregate.

11

PHOTOGRAPH, residential: the grain and joints of a dark plank floor.

12

ILLUSTRATION: a transition strip between plank and carpet tile.

This is an explainer combined with genuine photography, not a commercial project gallery. The photographs are real Elbaz Construction flooring work in residential interiors and are captioned as such - we have not relabelled them as commercial installations. The illustrations are created for this guide and are labelled as illustrations in their captions, their alt text and the media library.

01 / 12

The journey

Six stages, slab test to handover.

Commercial flooring fails in two predictable ways: it is bonded to a slab that was never tested and lifts within a year, or the programme ignores how the building is actually used and the work stops every morning at opening time. Both are decided long before anyone chooses a colour. This page walks the sequence in order, starting underneath.

Use the stage markers to jump straight to what you care about. Nothing here is a sales pitch - it is the sequence we actually follow.

Stage 01 · Survey

What is driving the project

Four reasons, and they lead to genuinely different specifications. Which one is yours changes the material, the programme and the tolerance for disruption.

The existing floor is worn out

The most common brief. The useful question is not what to replace it with but why it wore where it did - a floor that failed early at entrances and pinch points is telling you something about traffic that the replacement specification should answer.

  • Where a floor wore out first tells you where to specify harder
  • Entrances, corridors and turning points take disproportionate wear
  • Matting and entrance systems extend the life of everything past them
  • Replacing like-for-like repeats the original failure
  • This is the brief with the most freedom to improve on what was there
Close view of dark wide-plank flooring showing the grain and the plank joints

Flooring from our library: the grain and joints of a dark wide-plank floor.

The floor is lifting or failing early

When a bonded floor lifts, curls at the edges or smells, the cause is very often moisture coming up through the slab rather than a defective product. On grade-level slabs in South Florida this is a live issue, and it is testable before the next floor goes down rather than discoverable after it fails.

  • Adhesive failure is more often a slab problem than a product problem
  • Grade-level slabs here can carry significant moisture
  • Relative humidity in the slab is measured, not estimated
  • A moisture-mitigation coating is cheaper than laying twice
  • Manufacturers set limits, and warranties depend on meeting them

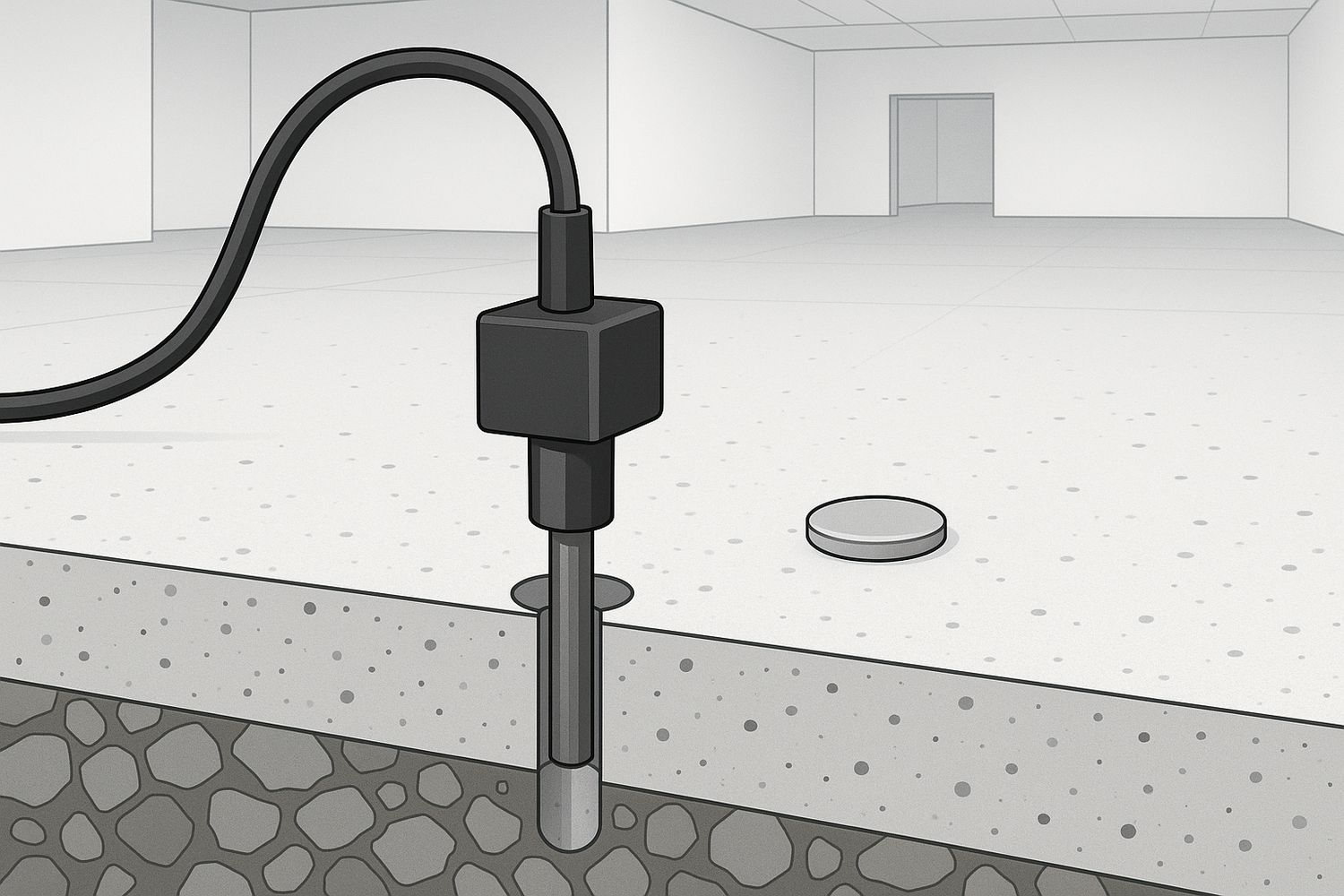

Illustration of relative-humidity probes set into a concrete slab for moisture testing (illustration)

Illustration: relative-humidity probes set into a slab for moisture testing.

A fit-out or a change of use

In a fit-out the floor is one trade among many and its position in the sequence matters more than its specification. Going down too early means it gets damaged by everyone after you; too late and it holds up handover. It also has to work with what the partitions and the furniture plan are going to do.

  • Sequence matters more than specification on a fit-out
  • Too early and every following trade damages it
  • Protection of a finished floor is a real cost, not an afterthought
  • Transitions have to be resolved with the partition layout
  • Under-partition versus wall-to-wall changes future flexibility
Wide-plank flooring running through a large open interior with shelving and seating

Flooring from our library: wide-plank running through a large open interior.

The space needs to look different

A floor is the largest single surface in most commercial interiors, so it does more to change how a space reads than anything else at the same cost. The constraint is that it also has to survive commercial traffic, and the finishes that photograph best are not always the ones that last in a corridor.

  • The floor is the largest surface and sets the whole room
  • What looks best in a showroom is not always what survives a corridor
  • Pattern and plank direction change how long a space feels
  • Acoustics are part of this: hard floors are louder
  • Slip resistance is a specification requirement, not a preference
Herringbone timber flooring laid across a large open space beside a glazed wall

Flooring from our library: herringbone laid across a large open span.

Stage 02 · Specify

The four decisions that set the job

These decide the cost, the programme and whether the floor is still performing in five years.

What the slab is doing

Before any material decision, the slab is tested for moisture and assessed for flatness. Bonded floors have manufacturer limits for slab relative humidity, and exceeding them voids warranties and causes the failures people blame on the product. Where readings are high, a mitigation coating goes down first.

  • Slab relative humidity is measured against the manufacturer limit
  • Exceeding it voids the warranty and causes the classic failures
  • Moisture mitigation is far cheaper than installing the floor twice
  • Flatness is measured too - it decides how the finish reads
  • This happens before the material is chosen, not after
Illustration of relative-humidity probes set into a concrete slab for moisture testing (illustration)

Illustration: moisture testing a slab before anything is bonded to it.

How much preparation it needs

Removing the old covering and its adhesive, grinding the slab back and levelling it is frequently a bigger line than the new floor. It is also the part that decides whether the finished floor looks flat under raking light. Skipping it is the most common false economy in this trade.

  • Old adhesive removal and grinding is real, chargeable work
  • Levelling decides how the finished floor reads under raking light
  • Thin resilient finishes telegraph every defect beneath them
  • Preparation is often a larger line item than the covering itself
  • Where the slab is sound, this shrinks considerably - so it is surveyed
Illustration of self-levelling compound spread over a prepared concrete subfloor (illustration)

Illustration: self-levelling compound over a prepared subfloor.

Which material actually suits

Resilient plank is hard-wearing, quiet enough and repairable. Carpet tile is replaceable one tile at a time, which matters where spills happen. Polished concrete has effectively no covering to fail. Resin suits back-of-house and wet areas. The right answer follows the traffic and the cleaning regime, not the mood board.

  • Resilient plank: hard-wearing, repairable, widely specified
  • Carpet tile: replace one tile rather than a room
  • Polished concrete: no covering to lift, and no adhesive to fail
  • Resin: seamless and cleanable, suited to back-of-house and wet areas
  • Slip resistance and cleaning regime are part of the specification

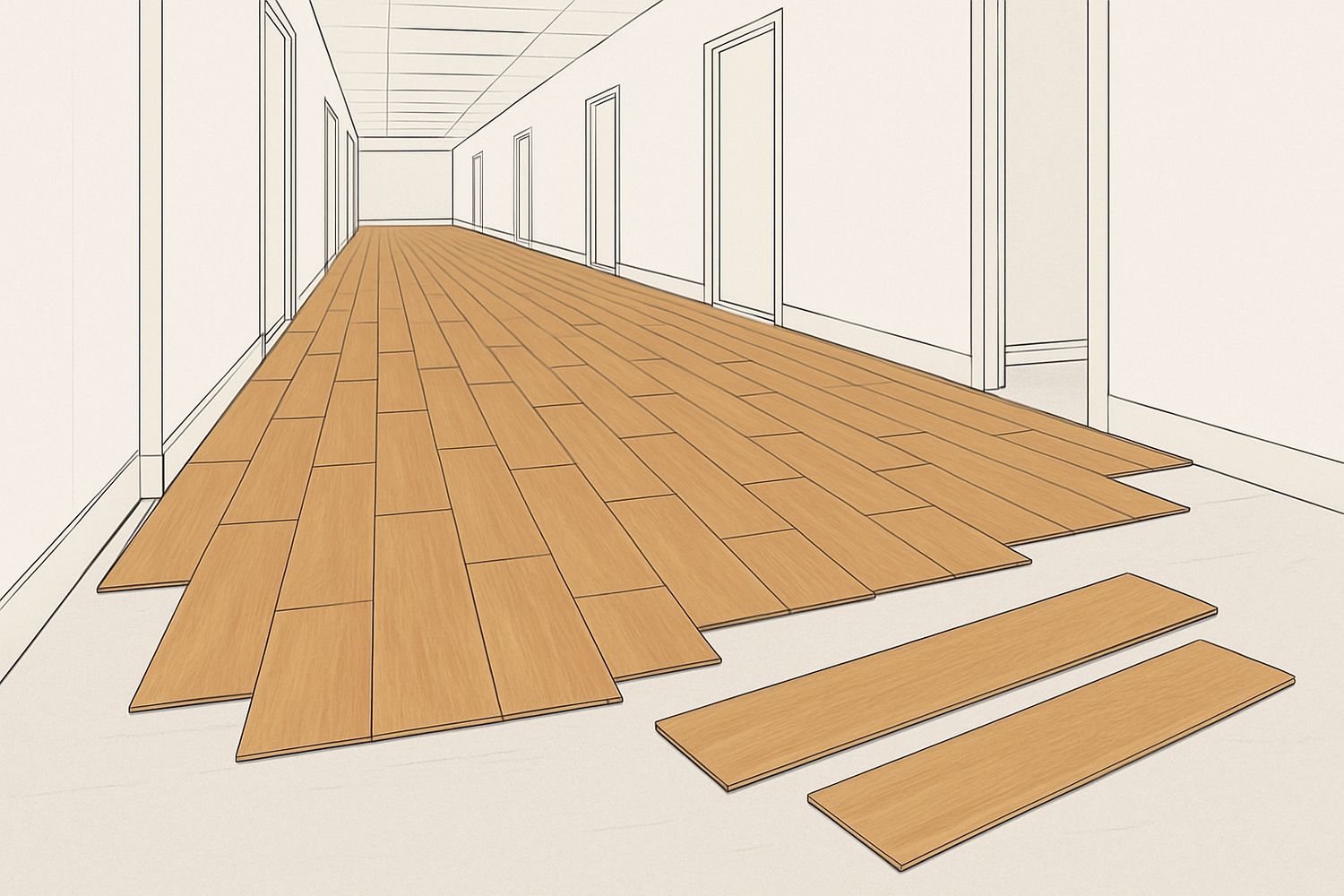

Illustration of luxury vinyl plank being laid in a staggered pattern along a corridor (illustration)

Illustration: resilient plank laid in a staggered pattern along a corridor.

How the work fits around you

Almost no commercial floor can be replaced in one go with the building closed. The work is split into areas, done out of hours where necessary, and each area is protected and handed back before the next opens up. That phasing is designed at the start, because it drives both the cost and the programme.

  • Work is split into areas and handed back as it completes
  • Out-of-hours working costs more and disrupts less
  • Adhesives and coatings need cure time before traffic returns
  • Temporary transitions and barriers are part of the scope
  • The phasing plan is agreed before the first area is opened

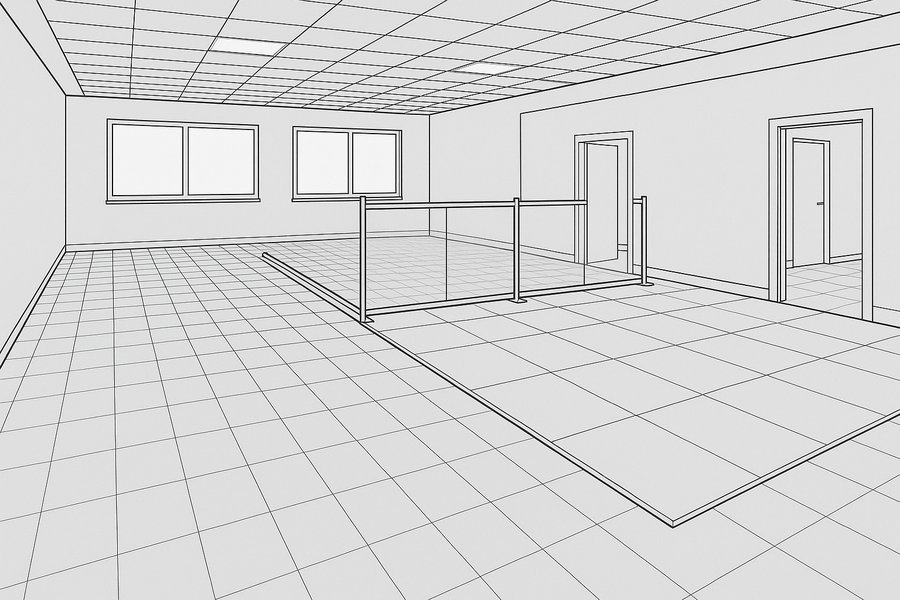

Illustration of a phased flooring installation with one half finished and protected (illustration)

Illustration: a phased installation with one area finished and protected.

The photographs on this page are genuine Elbaz Construction flooring photography, and they are residential interiors - we have said so in every caption rather than implying they are commercial installations. The commercial-specific images are illustrations drawn for this guide and are labelled as illustrations.

Stage 03 · Programme

Programme, access and approvals

On a commercial floor the programme is usually harder than the specification, because the building has other people in it.

The slab and the conditions

We measure the areas, test the slab for moisture, assess flatness and identify what the existing covering and adhesive actually are. Everything after this depends on it.

What has to come up

Removal method depends on what is down. Older adhesives in particular need identifying before anyone starts grinding, and where there is any doubt that is established properly rather than assumed.

Material against actual traffic

The covering is specified against the traffic, the cleaning regime and the slip-resistance requirement for the space, and against the moisture readings we took.

How the building keeps working

The floor area is divided into phases with a sequence, and out-of-hours working is priced where it is needed. This is agreed before anything starts.

Getting material in and waste out

Loading, lifts, protection of routes, and where a skip can stand. In an occupied building this frequently constrains the programme more than the work itself.

Where a landlord also approves

Tenancies and managed buildings often specify permitted working hours, acoustic requirements between floors, and approved methods. These are confirmed before the programme is fixed.

When traffic can come back

Adhesives, levelling compounds and coatings all have cure times before foot traffic and before furniture. These are built into the programme rather than hoped past.

Where the scope requires one

Flooring alone frequently does not require a permit, but where it is part of a wider fit-out, or where fire-rated or acoustic assemblies are affected, it does. We confirm it for your scope.

Keeping the finished floor finished

Completed areas are protected until handover, particularly where other trades are still working. This is scoped and priced rather than improvised.

Documented and maintainable

You get the product documentation, the warranty conditions and the manufacturer cleaning regime - the last of which is what actually determines how long the floor lasts.

Requirements, review times and inspection sequences are set by your local building department, and they differ across Miami-Dade, Broward and Palm Beach and between the municipalities inside them. Nothing here is a guaranteed timeline or an assurance of approval - we confirm what your address actually requires once we know it.

Stage 04 · Install

Installing it, in order

Everything below the covering happens first and most of it is invisible in the finished floor. That is exactly why it is where the job is won or lost.

Protection and setup

Before anything comes up

Routes protected, the working area separated from the part of the building still in use, and dust containment set up. Grinding a slab indoors is a serious dust operation.

Quality check · Containment up before any grinding starts

Illustration of a phased flooring installation with one half finished and protected (illustration)

Removal

The old covering and its adhesive

The existing floor comes up and the residual adhesive is removed. This is dirtier and slower than most people expect, and it is what the next floor bonds to.

Quality check · Slab taken back to a sound bonding surface

Illustration of self-levelling compound spread over a prepared concrete subfloor (illustration)

Slab testing

Confirming what we surveyed

Moisture readings are taken again on the exposed slab. A reading taken through an old covering is indicative; a reading on the bare slab is the one that governs.

Quality check · Readings confirmed on the exposed slab

Illustration of relative-humidity probes set into a concrete slab for moisture testing (illustration)

Moisture mitigation

Only where it is needed

Where readings exceed the manufacturer limit, a mitigation coating is applied and allowed to cure before anything is bonded over it.

Quality check · Mitigation applied and cured before bonding

Illustration of a seamless resin floor coating turning up the wall as a coved skirting (illustration)

Levelling

Making the slab flat

Levelling compound is applied and allowed to cure. Thin resilient finishes telegraph every defect underneath, so this stage decides how the finished floor reads.

Quality check · Flatness achieved before the covering

Illustration of self-levelling compound spread over a prepared concrete subfloor (illustration)

Setting out

Where the first row goes

The layout is set out from the space rather than from a wall, so that plank direction, pattern and cut sizes at the perimeter all land deliberately.

Quality check · Layout agreed before the first plank is bonded

Illustration of luxury vinyl plank being laid in a staggered pattern along a corridor (illustration)

Installation

The covering goes down

The covering is installed to the manufacturer method for the material - staggered plank, quarter-turn tile, or a poured and cured finish - working area by area to the agreed phasing.

Quality check · Installed to the manufacturer method

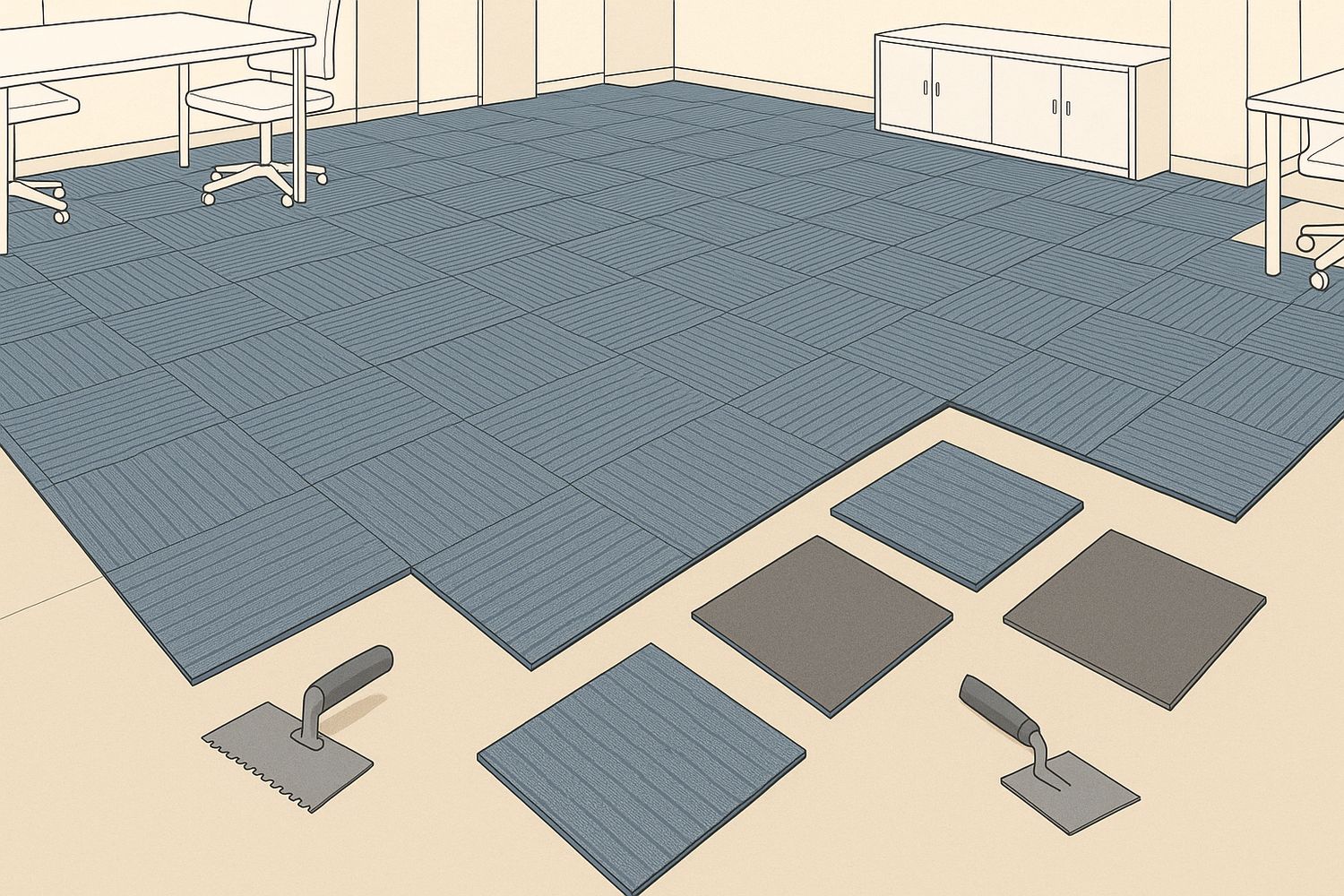

Illustration of carpet tiles laid in a quarter-turn pattern across an office floor (illustration)

Transitions and edges

Where finishes meet

Thresholds, transition strips, coved edges and skirtings are formed so the two finishes sit at the same level. This is the detail a commercial floor is judged on.

Quality check · Transitions level and mechanically fixed

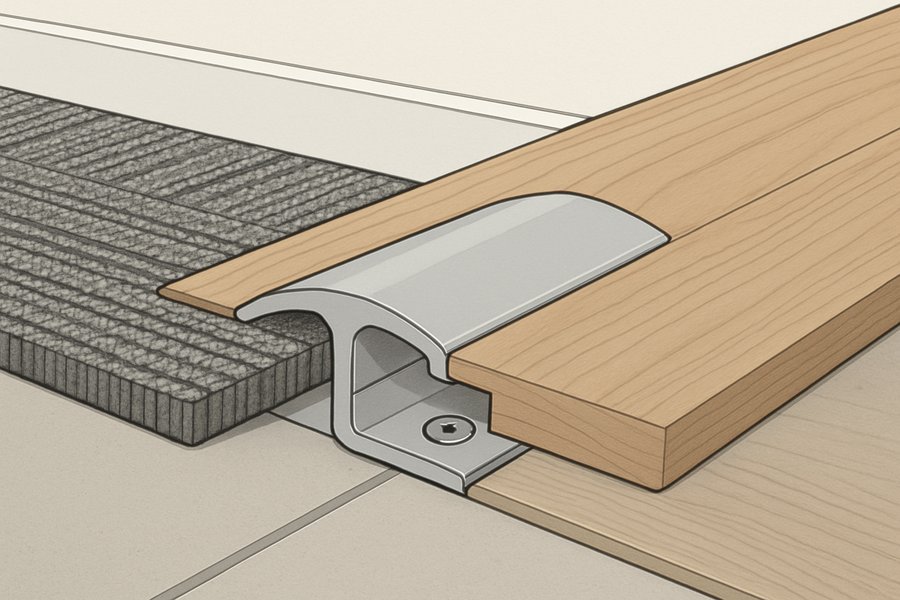

Illustration of a metal transition strip between plank flooring and carpet tile (illustration)

Cure and protection

Before traffic returns

Completed areas are protected and left to cure for the required period before furniture and foot traffic come back. Rushing this is how a new floor gets damaged in its first week.

Quality check · Cure times observed before handback

Illustration of a phased flooring installation with one half finished and protected (illustration)

Clean and handover

Handed back area by area

Each area is cleaned to the manufacturer initial-clean specification and handed back, and at completion you get the documentation and the maintenance regime.

Quality check · Initial clean done to the manufacturer specification

Light wide-plank flooring running uninterrupted across a large open room

Stage 05 · Inspect

The three decisions people find hardest

Balanced both ways. What is right depends on the traffic, the slab and how much the building can be disrupted.

Resilient plank

Hard-wearing and cleanable

Illustration of luxury vinyl plank being laid in a staggered pattern along a corridor (illustration)
How
Vinyl or composite planks bonded or loose-laid over a prepared slab.
Benefits
Very hard-wearing, easy to clean, water-tolerant, and individual planks can be replaced.
Limits
Louder underfoot than carpet, and it shows slab defects if the preparation was skipped.
Upkeep
Straightforward, but it needs the manufacturer regime rather than whatever is in the cupboard.
In South Florida
Water tolerance matters more here than in most markets.

Carpet tile

Quiet and replaceable

Illustration of carpet tiles laid in a quarter-turn pattern across an office floor (illustration)
How
Modular tiles laid in a quarter-turn or monolithic pattern.
Benefits
Quiet, warm underfoot, and damaged or stained tiles are swapped individually rather than by the room.
Limits
Holds soil and moisture, and needs a genuine cleaning programme. Not for wet or food areas.
Upkeep
Regular extraction cleaning, plus keeping attic stock for replacements.
In South Florida
Humidity makes the cleaning regime and the underlying moisture question more important.

Which oneFollow the traffic and the spill risk. Corridors, entrances, food areas and anywhere wet want resilient plank. Open-plan offices and meeting spaces are where carpet tile earns its place - and there is no reason not to use both, provided the transitions are detailed properly.

Treat the slab

Fix the cause

Illustration of relative-humidity probes set into a concrete slab for moisture testing (illustration)
How
A moisture-mitigation coating is applied to the slab before the covering is bonded.
Benefits
Lets you specify whatever floor the space actually needs, and protects the warranty.
Limits
An added cost and added cure time in the programme.
Upkeep
None - it is buried and permanent.
In South Florida
Frequently necessary on grade-level slabs, and far cheaper than laying the floor twice.

Specify around it

Work with the condition

Illustration of a polished concrete floor showing exposed aggregate and an even sheen (illustration)
How
Choose a finish that tolerates slab moisture - polished concrete, or a loose-lay system with no bonded adhesive.
Benefits
Avoids the mitigation cost entirely, and polished concrete removes the covering-failure question altogether.
Limits
Narrows the material choice considerably, and the aesthetic may not suit the space.
Upkeep
Polished concrete needs periodic re-polishing but has nothing to lift.
In South Florida
A genuinely practical answer where readings are high and the look suits.

Which oneIf the space needs a specific finish, treat the slab - it is a known cost and it protects the warranty. If the aesthetic is open, letting the slab condition steer you toward polished concrete or a loose-lay system is a legitimate and often cheaper answer.

Work out of hours

Stay open

Illustration of a phased flooring installation with one half finished and protected (illustration)
How
Work runs evenings, nights or weekends and the area is handed back before you open.
Benefits
The business keeps trading and staff keep working. Often the only viable option in retail or healthcare.
Limits
Costs more per hour, runs over more calendar weeks, and cure times still have to be respected between shifts.
Upkeep
None specific.
In South Florida
Building management rules on night working vary and need confirming early.

Close the area

Faster and cheaper

Illustration of self-levelling compound spread over a prepared concrete subfloor (illustration)
How
The area is taken out of use entirely and the work runs continuously.
Benefits
Materially quicker, cheaper per square foot, and a better result because nothing is rushed to reopen.
Limits
You lose the use of the space, which is a real business cost that has to be weighed.
Upkeep
None specific.
In South Florida
Easiest to schedule in a genuine seasonal lull.

Which oneCount the real cost of losing the space against the premium for out-of-hours work. Closing an area is almost always cheaper and produces a better floor, so it wins wherever the space can genuinely be spared - and phasing lets you close part of it rather than all of it.

What moves the cost and the calendar

Tick whatever applies. This will not produce a price - what is under the existing floor decides too much of it - but it will show which parts carry the cost and the calendar.

What this points to

We do not publish figures for this work, because the same scope can differ several-fold once the existing conditions are visible. You get a real, itemised number after a site visit, in writing.

Stage 06 · Operate

What a commercial floor replacement is actually like

A short sequence from our flooring photography, plus what the work actually involves on an occupied site. The disruption is real and it is worth planning rather than absorbing.

How long it runs

It depends far more on the phasing than on the area. The same floor replaced in one closed run can take a fraction of the calendar it takes replaced area by area out of hours - and we will give you both numbers.

The dusty part

Removing the old covering and grinding the slab. It is contained, but it is the stage that most affects the rest of the building, and it is worth scheduling deliberately.

Noise

Grinding is loud and it carries through a structure to floors above and below. In a managed building this frequently drives the working hours more than anything else.

Smell

Adhesives and coatings have an odour while curing. Low-odour products exist and are specified where the space is sensitive, but ventilation is planned either way.

Waiting for cure

Levelling compound, adhesive and coatings all need time before traffic. This is the part clients most often want to compress, and the part where compressing it costs the most.

Furniture

It has to move, and moving it is a real line in the programme. Who does it - us or you - is agreed at the start rather than on the day.

Protection

Finished areas are covered until handover if other trades are still on site. An unprotected new floor gets damaged in its first week, reliably.

Handover

Each area is cleaned to the manufacturer initial-clean specification and handed back. You get the maintenance regime, which genuinely determines how long the floor lasts.

Why the contractor matters on a commercial floor

Only claims we can stand behind. Everything below is either a matter of public record or visible in the work shown on this page.

Licensed, bonded and insured

Elbaz Construction is a licensed general contractor, CBC1265280. Where flooring forms part of a wider permitted fit-out, permits are pulled in the company name.

We test the slab

Moisture readings are taken on the bare slab and checked against the manufacturer limit, because that is the difference between a warranty that holds and one that does not.

Preparation is priced honestly

Adhesive removal and levelling are quoted as the real work they are, not buried and then raised as a variation once the old floor is up.

Phasing designed around your hours

The sequence, the out-of-hours element and the handback of each area are agreed before anything starts.

Cure times are respected

We will not hand an area back early because it would be convenient. It is the fastest way to ruin a new floor.

Transitions detailed properly

Every junction between finishes is designed and mechanically fixed, not covered with a strip at the end.

One contractor across the trades

Where flooring sits inside a wider fit-out, the same company coordinates it with everything else on the programme.

Documentation at handover

Product data, warranty conditions and the manufacturer cleaning regime, handed to whoever maintains the building.

Questions, by stage

Filter to the part of the job you are thinking about.

Why does my floor keep lifting?Before starting

Nine times out of ten it is moisture in the slab rather than a defective product. Bonded floors have manufacturer limits for slab relative humidity, and when those are exceeded the adhesive fails. It is testable in a day, and testing it before the next floor goes down is the whole point.

Do you have to remove the old floor?Before starting

Usually, yes. The new covering bonds to what is underneath, so the old adhesive has to come off and the slab has to be sound. Laying over an existing floor is occasionally possible but it inherits every problem below it.

Can you work while we stay open?Before starting

Yes - most commercial flooring is done that way. The area is split into phases, work runs out of hours where it has to, and each area is protected and handed back before you open. It costs more per hour and disrupts far less.

What is the most hard-wearing commercial floor?Design

For most spaces, resilient plank or polished concrete. Polished concrete has no covering to lift and no adhesive to fail, which removes the most common failure mode entirely. Resilient plank is more forgiving underfoot and individual planks can be replaced.

Carpet tile or broadloom?Design

Tile, in almost every commercial case. A stained or damaged tile is swapped individually instead of replacing a room, and holding attic stock means later repairs actually match.

Does slip resistance matter?Design

Yes, and it is a specification requirement rather than a preference, particularly at entrances, in wet areas and anywhere food is handled. It is confirmed against the use of each space rather than applied uniformly.

How do you test a slab for moisture?Planning

Probes are set into small drilled holes in the slab and left to equilibrate before relative humidity is read. It is done on the bare slab, because a reading taken through an existing covering is only indicative.

What if the moisture reading is too high?Planning

Either a mitigation coating goes down first, or the specification moves to something that tolerates the condition - polished concrete or a loose-lay system with no bonded adhesive. Both are legitimate; we will price both.

Does commercial flooring need a permit?Planning

Flooring on its own frequently does not. Where it forms part of a wider fit-out, or affects fire-rated or acoustic assemblies, it does. We confirm it for your specific scope rather than assume either way.

What will our building manager want to know?Permits

Usually working hours, noise, the acoustic build-up between floors, protection of common parts, and how waste leaves the building. It is worth getting the fit-out conditions from them early - they frequently drive the programme.

How long before we can walk on it?Construction

It depends on the material and the adhesive, and again before furniture goes back. Those cure times are built into the programme, and they are the one part we will not compress.

Who moves the furniture?Construction

Either of us, but it is agreed and priced at the start rather than discovered on the morning. It is a real line in the programme, not an afterthought.

How much dust will there be?Construction

Removal and grinding are genuinely dusty. Containment goes up first and extraction is used at the machine, but in an occupied building this stage is scheduled deliberately rather than just started.

Why is preparation such a big part of the quote?Cost

Because it is a big part of the work. Removing old adhesive, grinding and levelling a slab is slow, and it is what the finished floor depends on. A quote that looks cheap has usually assumed the slab is perfect.

What makes a commercial floor more expensive?Cost

In rough order: adhesive removal, moisture mitigation, levelling a poor slab, out-of-hours working, heavy phasing, and stairs. The covering itself is often not the largest line.

What do we get at handover?Completion

The product documentation, the warranty conditions and the manufacturer cleaning regime, plus any attic stock. The cleaning regime is the one that matters - most premature commercial floor failure is a maintenance problem.

How do we look after it?Maintenance

Follow the manufacturer regime for the specific material, and put proper matting at entrances. Entrance matting extends the life of everything past it more than any other single measure.

Can damaged areas be repaired later?Maintenance

With modular materials, yes - that is a large part of why they are specified. Individual planks or tiles are replaced, which is why holding attic stock from the original batch is worth doing.

Client experience

What clients say, in their own words

Live Google reviews for Elbaz Construction, pulled straight from our Google Business Profile — not retyped, not edited and not selected by us.

Reviews are served live by the site's own Google Reviews plugin and update as new ones are posted. Nothing here is retyped, shortened or re-attributed.

Project files

No warehouse here. Related floors, labeled.

The photos here are commercial and residential floors that show the materials and detailing commercial work uses. These sets show the same trades and finishes in other settings: a residential porcelain floor, a nail salon and a mixed collection that includes an office lounge.

3Projects shown
11Photos
PROJECT 01

Residential kitchen with large-format tile floor

This is a house, not a commercial space. It is shown because the floor is large-format porcelain tile laid continuously from a kitchen island through to the sliders of a screened lanai. Few joints and a single material make it a useful reference for a long, open commercial floor.

Scope of work

  • Large-format porcelain tile laid across the full open space
  • Continuous floor from kitchen to lanai doors
  • Plank flooring transitioned cleanly to large-format tile at a bathroom threshold
  • Floor kept flat enough for a long run of large tile
  • Hexagonal mosaic tile set into the shower floor at the drain
  • Same material carried to the threshold at the sliders

Materials & finishes

Large-format porcelainQuartz waterfall islandFlat-panel cabinetsPlank-to-tile thresholdMarble feature wall

What to look for in the photos

Follow the grout lines across the floor. In large tile they stay straight over a long run only when the slab beneath is flat.

Elbaz Construction project photo · 5 photos

PROJECT 02

Related interior: polished porcelain at a nail salon

A nail salon and spa, shown as a related commercial interior and not as the building type on this page. One photo shows a glossy marble-look porcelain floor beside a chair with a gold base. Two close-ups show mirrored hexagon tile beside a white glass vanity top.

Scope of work

  • Polished marble-look porcelain laid across the salon floor
  • Floor tile run up to chair bases and fixtures
  • Mirrored hexagon tile set beside a vanity counter
  • Glass vanity top fitted against the tile
  • Finish chosen to read clean under salon lighting
  • Surfaces detailed for daily cleaning

Materials & finishes

Polished porcelainMarble-look tileMirrored hexagon tileGlass vanity topGold chair base

What to look for in the photos

A glossy floor shows every high or low tile edge, which is why a polished commercial floor needs a very flat substrate.

Elbaz Construction project photo · 3 photos

PROJECT 03

Resilient and wood floors, three jobs

A collection from three separate jobs, not one building. An office lounge has a luxury vinyl plank floor, a showroom has a dark wood plank floor beside tile sample boards, and a large room with a pool view has light gray vinyl plank.

Scope of work

  • Luxury vinyl plank in an open office lounge
  • Dark wood plank floor in a showroom
  • Light gray vinyl plank across a large open room
  • Plank direction set to run with the room
  • Transitions and edges kept straight to the wall
  • Floors installed before furniture and stock moved in

Materials & finishes

Luxury vinyl plankDark wood plankLight gray plankBaseboard trimTile sample boards

What to look for in the photos

Compare how the plank lines run in each room. In a long space, straight lines show whether the first row was set out well.

Collection: photos from several Elbaz Construction jobs · 3 photos

Budget and schedule

Where a commercial floor goes.

Most of the money sits in the material and the slab work beneath it. These are typical shares and a typical sequence for a mid-size commercial floor.

Where a typical commercial flooring budget goes

100%OF BUDGET
  • Removal and disposal8%
  • Slab testing and preparation18%
  • Flooring material32%
  • Adhesive, trim and accessories8%
  • Installation labor22%
  • Phasing, protection and permits12%

Typical shares only; slab condition and phasing around your opening hours move them.

A typical commercial floor sequence, in weeks

Selections and samples
Slab moisture and flatness testing
Access plan and phasing agreed
Material ordering and delivery
Lead time
Removal and slab preparation
Installation in phases
Cure, walk-through and handover
Week 0Week 7Week 14

Ordering runs alongside slab testing, so lead time rarely adds to the total.

Drawn out

What sits under a commercial floor.

Three drawings show the layers, the plank option and the slab work that decide how long a floor lasts.

TILE OVER SLABPorcelain / tileThinset (95% coverage)Crack-isolation membraneConcrete slabVapor barrier + soil

Tile over a slab

Tile sits on a mortar bed over the concrete slab, which is why slab moisture and flatness are measured before any tile is ordered.

FLOATING LVP FLOORWear layerPrinted design layerRigid SPC coreAttached pad6-mil vapor barrierFlat slab (3/16 in in 10 ft)

Plank for fast turnaround

A floating plank floor goes down in less time than tile and can often be laid in sections, which suits spaces that need to reopen quickly.

OUT OF FLATGROUND + SELF-LEVELEDREMOVE · GRIND · PATCH · LEVEL

Uneven slab to flat

Grinding high spots and filling low ones brings the slab inside the flatness the flooring maker allows, before any material is laid.

Scope planner

Size up your floor.

Pick the closest options to see the trades involved and typical weeks on site.

What size is the area?
What new floor do you want?
What is down now?
Must the space stay open?

More questions

Leases, slabs and open doors.

What commercial tenants and owners ask about scope, insurance, humidity and the schedule.

Ask us directly
What should we send you to scope a commercial floor?

A floor plan with the area marked, photos of what is down now and your lease or building rules on working hours are enough to start. We confirm the rest on site: slab condition, access, elevator or dock limits and any areas that must stay in use. A short visit usually replaces long email exchanges.

Does our landlord need to approve a flooring change?

In most leases and in condo or plaza associations, yes. Approval often needs the material, a short scope of work and a certificate of insurance naming the landlord. We can supply that paperwork. Get approval before material is ordered, because some buildings limit hours, elevator use or noisy work.

What about floor outlets and data boxes in the slab?

They must be located and set to the finished floor height before flooring starts. A box left too low or too high shows as a lip or a gap. We mark each one on the plan, confirm the cover type with your electrician or cabling contractor, and set trim to suit the floor.

Does Florida humidity change how a floor is installed?

Yes. High humidity slows adhesive and mortar cure times and raises the moisture a slab gives off. We test the slab, let materials adjust in the space where the manufacturer asks for it, and keep air conditioning running during the work. Skipping those steps is a common cause of later lifting.

How do we keep rainwater from ruining an entrance floor?

Plan for wet shoes in the entrance from the first day. Walk-off mats or recessed matting trap most of it, and a floor with a slip rating suited to wet areas helps the rest. Keep the entrance material and its transition detail in the scope, because water at a threshold finds every gap.

How early should we order flooring for a lease deadline?

Order as soon as the product is chosen. Lead times vary by product and by maker, and special sizes or colors can take longer than stock items. Count back from the date you need the space and allow time for slab testing, so a late delivery does not delay the whole opening.

Does hurricane season affect a commercial flooring job?

It can. A named storm may close the site, delay deliveries or require protecting the open slab, and a storm that floods a space changes the scope entirely. We keep materials off the floor, avoid leaving prepared slab exposed and plan the start dates so installed areas are not caught unfinished.

Can rolling carts or heavy equipment damage a new floor?

Yes, if the floor was not chosen for the load. Point loads from racks, wheels and equipment can dent resilient floors and crack weak tile. Tell us what will roll or stand on the floor, and we will suggest a material and a protection plan for the first weeks after installation.

Start here

Book the site visit

Tell us the approximate area, what is down now and how the space is used. That is enough for a genuinely useful first conversation.

What happens next

  1. We read it properly and come back to you, usually the same or next working day.
  2. A short call to understand the property and what is driving the project.
  3. A site survey - we measure the areas, test the slab for moisture and establish what the existing covering and adhesive actually are.
  4. A written, itemised proposal with the scope set out, including how unknowns are handled.
  5. If you go ahead, we prepare and file any permit before work starts.
Preferred contact method

We use your details only to respond to this enquiry. No lists, no resale.

Thanks — that came through.

Your details are with the Elbaz Construction team and we will come back to you, usually the same or next working day. If it is urgent, call (754) 236-0675.

Dark wide-plank flooring in an open interior with material sample boards on display stands

Test the slab before you choose the floor.

Almost every commercial floor that fails early failed underneath. One day of testing decides the specification and protects the warranty.
