A multi-family building
is not a bigger house.
It is what sits between the units.

Anyone can draw more bedrooms. What makes a multi-family building work is everything between the dwellings: rated separation, sound, stacked services, corridors that are also escape routes, and a meter for every unit. We build ground-up across Miami-Dade, Broward and Palm Beach, with the entitlement and the permitting handled in-house.

  • Licensed, bonded & insured · CBC1265280
  • 104 municipalities across 3 counties
  • Design-build: permitting & construction in-house

Miami-Dade · Broward & Palm Beach Counties

Scroll

Recent projects

Ground-up work, and multi-family detail

Twelve images. Six are genuine Elbaz photographs of a ground-up build in progress - a single-family house - and six are illustrations drawn for this guide. Tap any image to see it larger; each caption says which.

01

PHOTOGRAPH, single-family build: structure and glazing in place.

02

ILLUSTRATION: a rated separation wall between two dwellings.

03

PHOTOGRAPH, single-family build: a double-height interior at drywall stage.

04

ILLUSTRATION: a vertical riser serving stacked units.

05

PHOTOGRAPH, single-family build: glazing installed, looking to the water.

06

ILLUSTRATION: a common corridor and the exit stair beyond.

07

PHOTOGRAPH, single-family build: the stair structure going in.

08

ILLUSTRATION: the floor assembly between stacked dwellings.

09

PHOTOGRAPH, single-family build: the lot and its seawall.

10

ILLUSTRATION: dwellings carried above ground-level parking.

11

PHOTOGRAPH, single-family build: working at height during drywall.

12

ILLUSTRATION: an enclosed exit stair through three levels.

This is an explainer combined with genuine photography, not a multi-family project gallery. The photographs are real Elbaz Construction ground-up construction work on a single-family build and are captioned as such - we have not relabelled them as a multi-family development. The illustrations are created for this guide and are labelled as illustrations in their captions, their alt text and the media library.

01 / 12

The journey

Six stages, site feasibility to certificate of occupancy.

Multi-family projects almost never fail on construction. They fail earlier - on a density the zoning would not carry, a utility connection nobody confirmed, or a parking requirement that quietly deleted four units. This page walks the sequence in the order it genuinely happens, starting with the only question that matters at the beginning: what will this site actually take?

Use the stage markers to jump straight to what you care about. Nothing here is a sales pitch - it is the sequence we actually follow.

Stage 01 · Feasibility

What kind of building it is going to be

Four common shapes, and they are genuinely different projects - different structure, different parking, different approval route.

A small infill building

The most common multi-family project here, and the most achievable. A small building on an infill lot behaves much like a large house until you cross the thresholds where rated separation, accessibility and multiple egress routes begin to apply - and knowing exactly where those thresholds fall is most of the early design work.

  • Unit count drives which requirements engage, and the steps are sharp
  • Accessibility requirements apply to covered multi-family buildings
  • Parking provision is frequently what limits the unit count
  • A single stair may or may not be permissible depending on the design
  • Structure is often familiar residential construction at this scale
Two-storey ground-up build under construction, structure and glazing in place, seen from the lot

Real photograph: ground-up construction, structure and glazing in place. This is a single-family build.

Attached townhomes

Townhomes trade the corridor for a party wall. Each dwelling has its own entrance and often its own garage, so there is no common circulation to build or maintain - but the wall between each pair of homes becomes a rated, acoustically separated assembly that runs the full height of the building.

  • No common corridor, so no shared circulation to build or maintain
  • The party wall is rated and continuous, full height
  • Sound separation between homes is designed, not assumed
  • Each unit is typically separately metered and serviced
  • Often the simplest multi-family form to phase and to sell
Illustration of a fire-rated double-stud separation wall between two dwelling units (illustration)

Illustration: a fire-rated separation wall between two dwelling units.

Stacked flats

Stacking is where multi-family becomes genuinely its own discipline. Sound travels between floors, services have to stack vertically to be buildable, the corridor is also an escape route, and every dwelling needs its own metering. The plan is disciplined by all of that at once.

  • Services stack vertically or the plan does not work
  • Floor and ceiling assemblies carry sound separation requirements
  • The corridor is egress, and egress governs its width and protection
  • Two protected means of escape are normally required
  • Every dwelling is separately metered
Illustration of a common corridor with unit entrance doors and an exit stair beyond (illustration)

Illustration: a common corridor with unit entrance doors and an exit stair beyond.

Building over parking

Where the site cannot spare ground for both parking and building, the parking goes underneath. That brings a structural transfer level, a different construction type and a different cost base - but it is frequently the only way the numbers work on a constrained urban lot, and in flood-prone areas raising the dwellings has a second benefit.

  • A transfer structure carries the dwellings over the parking below
  • Construction type and structural system usually change with it
  • It is often the only way to make a constrained site viable
  • Raising dwellings above grade can help in flood-prone locations
  • Ventilation and drainage of the parking level are designed in
Illustration of residential floors carried on a transfer level above ground-level parking (illustration)

Illustration: residential floors carried on a transfer level above ground-level parking.

Stage 02 · Design

The four decisions that set the building

Everything else is finishes and specification. These four decide the structure, the approval route and the cost per unit.

How many units the site carries

Density, height, setbacks, lot coverage and parking together decide the unit count, and parking is very often the binding constraint rather than density. This is established against the actual parcel before any design work, because every hour spent designing to the wrong number is wasted.

  • Density, height, setbacks and coverage all bind at once
  • Parking provision frequently limits units before density does
  • Rules differ sharply between the 104 municipalities here
  • Impact fees and concurrency belong in the early numbers
  • A rezoning or variance is a separate process with its own timeline
Illustration of a multi-family construction site with laydown area and crane position (illustration)

Illustration: a multi-family site with laydown area and crane position.

What sits between the dwellings

The assemblies between dwellings have to do two jobs: resist fire for a required period, and control sound transmission. They are related but not the same, and an assembly that satisfies one can be poor at the other. Getting both right is designed at assembly level, and it is what residents actually notice once they move in.

  • Rated separation between dwellings is a code requirement
  • Sound transmission requirements apply to those same separations
  • Fire performance and acoustic performance are not the same thing
  • Impact sound between stacked units needs a resilient layer
  • Penetrations through a rated assembly must be properly firestopped
Illustration of a floor and ceiling assembly with a resilient layer between stacked units (illustration)

Illustration: a floor assembly with a resilient layer between stacked units.

How the services stack

In a stacked building, kitchens and bathrooms need to sit above one another so drainage, supply and ventilation can run in continuous vertical risers. A plan that ignores this is buildable only at considerable cost. It is the single most common reason an attractive early layout has to be reworked.

  • Wet rooms stack so risers can run straight
  • Every riser penetration through a rated floor is firestopped
  • Separate metering for each dwelling is planned into the layout
  • Mechanical equipment placement is a design decision, not a leftover
  • A plan that ignores stacking gets reworked, usually late
Illustration of a vertical plumbing riser serving stacked units on three floor levels (illustration)

Illustration: a vertical riser serving stacked units on three levels.

Corridors, stairs and getting out

Common circulation in a multi-family building is an escape route before it is a hallway. That governs its width, its protection, the travel distance from the furthest dwelling door, and the number of stairs. It also has to be accessible, which affects levels, door hardware and clear widths throughout.

  • Corridor width and protection follow egress requirements
  • Travel distance from the furthest door is a real design constraint
  • Normally two protected means of escape are required
  • Accessible routes govern levels, thresholds and clear widths
  • Common areas carry accessibility requirements of their own
Illustration of an enclosed exit stair running through three levels of a building (illustration)

Illustration: an enclosed exit stair running through three levels.

The photographs on this page are genuine Elbaz Construction ground-up construction photography of a single-family build, and every caption says so - we are not presenting it as a multi-family project. The multi-family-specific images are illustrations drawn for this guide and are labelled as illustrations.

Stage 03 · Entitle

Feasibility, entitlement and utilities

This is where multi-family projects are actually decided. By the time you are pricing structure, the important questions have all been answered.

What the parcel will carry

Density, height, setbacks, coverage and parking are established against the actual parcel and its zoning designation, before any design work begins.

Units, parking and the trade between them

A realistic unit count with its parking provision, because parking is frequently what limits yield rather than density. This is the number the whole project is then designed to.

Whether services can actually reach it

Water, sewer, power and stormwater capacity are confirmed with the providers. Capacity at the connection point is a genuine constraint on multi-family, not a formality.

Where the water goes

Drainage, retention and finished floor levels are established early. In South Florida this interacts with flood zone requirements and it can reshape the site plan.

Units, cores and the space between

Layouts are developed with the stacking discipline, rated separation and egress built in from the first sketch rather than applied afterwards.

Structure, civil, MEP

Structural design including the wind criteria that apply here, plus civil, mechanical, electrical and plumbing, all coordinated into one set.

Designed in, not retrofitted

Covered multi-family buildings carry accessibility design requirements for units and common areas. These are designed in from the start, because retrofitting them is expensive and sometimes impossible.

Where approval is more than a permit

Some schemes need only a building permit; others need site plan approval, a rezoning or a variance, each with its own public process and calendar.

Filed as one coordinated set

The full set is submitted to your municipality, or the county where unincorporated. Review comments are answered and the set resubmitted.

The costs outside the build

Impact fees, connection charges and concurrency requirements are real costs on multi-family and belong in the numbers from the beginning rather than as a surprise before permit issue.

Requirements, review times and inspection sequences are set by your local building department, and they differ across Miami-Dade, Broward and Palm Beach and between the municipalities inside them. Nothing here is a guaranteed timeline or an assurance of approval - we confirm what your address actually requires once we know it.

Stage 04 · Build

Building it, in order

Multi-family runs the same sequence as any ground-up build, with two differences: everything repeats across units, and the assemblies between dwellings have to be right before they are covered up.

Site works

Clearing, grading, drainage

Clearing, grading, stormwater infrastructure and the underground utilities that will serve the building. Most of the first phase ends up buried and invisible.

Quality check · Drainage and services in before anything goes vertical

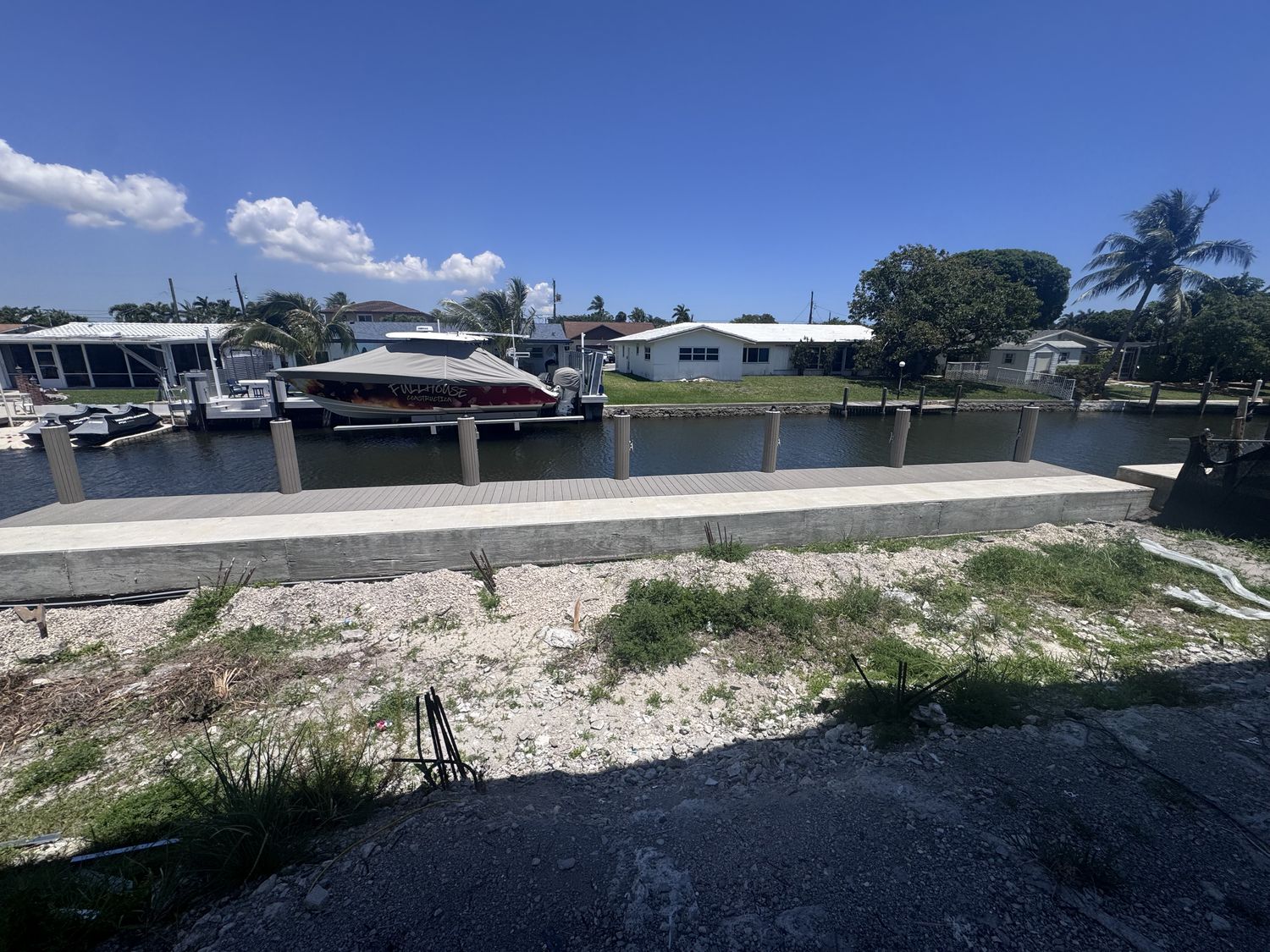

Cleared waterfront construction lot on a canal with a seawall and docks beyond

Foundations

What carries the building

Foundations to the engineered design, including any transfer structure where the building sits over parking. Inspected before concrete is placed.

Quality check · Reinforcement inspected before the pour

Illustration of residential floors carried on a transfer level above ground-level parking (illustration)

Structure

Frame and floors

The structure goes up floor by floor to the engineered design, including the wind requirements that apply here. This is when the building becomes real very quickly.

Quality check · Structural inspections as each level completes

Two-storey ground-up build under construction, structure and glazing in place, seen from the lot

Envelope

Making it weathertight

Roof, glazing, doors and the weather barrier, so interior work can proceed regardless of the afternoon storms. On a multi-level building this happens in a rolling sequence.

Quality check · Each level dried in before interior work starts

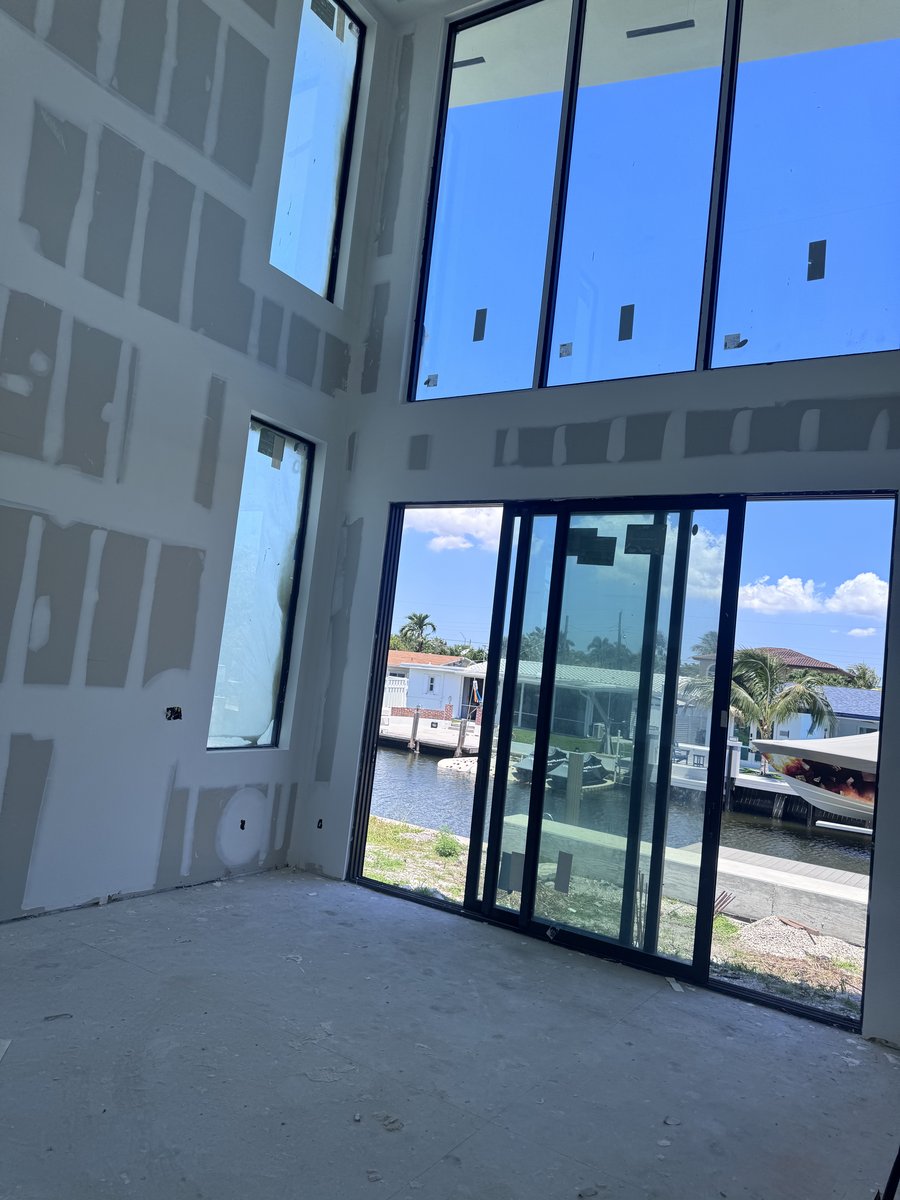

Full-height sliding glazing installed in a building under construction, looking out to a canal and docks

Separation assemblies

The walls and floors between dwellings

Rated separation walls and floor assemblies are built to the tested detail, with every penetration firestopped. Getting this right before it is covered is the whole job.

Quality check · Rated assemblies inspected before closing up

Illustration of a fire-rated double-stud separation wall between two dwelling units (illustration)

Services rough-in

Stacked and metered

Risers, branch services and the metering arrangement are installed. Every penetration through a rated assembly is firestopped as it is made, not afterwards.

Quality check · Rough-in inspected with the assemblies still open

Illustration of a vertical plumbing riser serving stacked units on three floor levels (illustration)

Acoustic layers

Before the floors go down

Resilient layers and ceiling isolation go in as designed. This is the part residents notice most and the part that cannot be added later at any sensible cost.

Quality check · Resilient layers verified before the floor finish

Illustration of a floor and ceiling assembly with a resilient layer between stacked units (illustration)

Interior fit-out

Repeated across every unit

Insulation, board, floors, joinery, tiling and fittings, repeated unit by unit. Consistency across units matters more here than in any single house.

Quality check · First unit set out as the benchmark for the rest

Double-height interior under construction with full-height glazing and drywall going up

Common areas and egress

Corridors, stairs, accessibility

Corridors, stair enclosures, entrance doors and the accessible route are completed and checked against the approved drawings rather than approximated.

Quality check · Egress routes and clear widths verified as built

Illustration of a common corridor with unit entrance doors and an exit stair beyond (illustration)

Finals and certificates

Signed off, then handed over

Final inspections across every trade, then the certificate of occupancy. On a phased scheme this can be building by building rather than all at once.

Quality check · Certificate of occupancy before anyone moves in

Illustration of a bank of separate electrical meters serving individual dwelling units (illustration)

Stage 05 · Inspect

The three decisions people find hardest

Balanced both ways. What is right depends on the parcel, the market and how the scheme is being funded.

Attached townhomes

No common circulation

Illustration of a fire-rated double-stud separation wall between two dwelling units (illustration)
How
Units side by side, each with its own entrance at grade and a rated party wall between.
Benefits
No corridors, lobbies or common circulation to build or maintain. Simpler to phase, and generally simpler to sell individually.
Limits
Uses far more land per unit, so yield is lower on a constrained parcel.
Upkeep
Much less common area, so lower ongoing association burden.
In South Florida
Works well where land allows and the market wants fee-simple homes.

Stacked flats

More units per acre

Illustration of a common corridor with unit entrance doors and an exit stair beyond (illustration)
How
Dwellings stacked above one another, accessed from a common corridor.
Benefits
Materially higher yield on the same parcel, and shorter service runs where units stack cleanly.
Limits
Corridors, stairs, lifts and lobbies all have to be built and maintained, and sound between floors becomes a primary design concern.
Upkeep
Significant common area, and an association structure to run it.
In South Florida
Usually the only way to reach viable density on an urban infill parcel.

Which oneLand cost usually decides this before preference does. Where the parcel is generous, townhomes are simpler to build, sell and maintain. Where it is not, stacking is what makes the site work at all - and then sound separation deserves real money rather than the minimum.

Surface parking

Cheap, but it eats the site

Illustration of a multi-family construction site with laydown area and crane position (illustration)
How
Parking at grade alongside the building.
Benefits
Far cheaper to build, simple drainage, and no structural transfer.
Limits
Consumes a great deal of land, which directly reduces how many units the parcel can carry.
Upkeep
Resurfacing and drainage maintenance, both straightforward.
In South Florida
Fine where land is affordable; increasingly hard to justify where it is not.

Build over parking

Buys back the footprint

Illustration of residential floors carried on a transfer level above ground-level parking (illustration)
How
Parking at ground level with a structural transfer level carrying dwellings above.
Benefits
Recovers the whole parking footprint as developable area, and raises the dwellings above grade.
Limits
A transfer structure is expensive, usually changes the construction type, and brings ventilation and drainage requirements for the parking level.
Upkeep
A structure to maintain rather than a surface.
In South Florida
Raising dwellings above grade has a genuine second benefit in flood-prone locations.

Which oneIt is arithmetic: compare the cost of the transfer structure against the value of the units it lets you build. On an expensive urban parcel that comparison usually favours building over the parking; on a cheaper suburban one it rarely does.

One phase

Fastest and cheapest per unit

Two-storey ground-up build under construction, structure and glazing in place, seen from the lot
How
The whole scheme is built as a single programme.
Benefits
One mobilisation, one set of site infrastructure, continuous trade sequences, and the lowest cost per unit.
Limits
The largest capital requirement, and every unit reaches the market at the same moment.
Upkeep
One completion, one handover.
In South Florida
Also means one hurricane season to build through rather than several.

Phased delivery

Revenue earlier, costs spread

Illustration of a multi-family construction site with laydown area and crane position (illustration)
How
The scheme is split into phases, each reaching its own certificate of occupancy.
Benefits
Earlier units can be sold or let while later ones are still building, which helps fund the rest and tests the market.
Limits
Repeated mobilisation, a longer overall programme, and a live construction site next to occupied homes.
Upkeep
Managing occupied and under-construction areas together.
In South Florida
Site infrastructure usually has to be sized for the whole scheme in phase one regardless.

Which oneIf it is funded, one phase is cheaper per unit and finishes sooner. Phasing is a funding and market-risk decision - a legitimate one - but plan the whole site in phase one, because the drainage and utilities have to be sized for the finished scheme either way.

What moves the cost and the calendar

Tick whatever applies. This will not produce a price - on multi-family the site and the entitlement route move the number more than the building does - but it will show which parts carry the cost and the calendar.

What this points to

We do not publish figures for this work, because the same scope can differ several-fold once the existing conditions are visible. You get a real, itemised number after a site visit, in writing.

Stage 06 · Occupy

What a ground-up multi-family build is actually like

A short sequence from our ground-up construction photography, plus what the programme actually involves. Multi-family runs in years rather than months once entitlement is counted.

How long it runs

Construction runs in many months. Feasibility, entitlement and permitting frequently take as long again before it starts, and on a scheme needing rezoning or site plan approval, longer.

The first phase is invisible

Site works, drainage and underground utilities consume a real part of the programme and produce nothing you can photograph. It is normal, and it is not slow progress.

Then it moves quickly

Once the structure starts going up, visible progress is rapid. That phase is also where the weather has the most influence on the schedule.

Repetition is the point

Multi-family gets its efficiency from doing the same thing many times. The first unit is set out carefully as the benchmark, and the rest follow it.

Inspections gate everything

Rated assemblies, firestopping and rough-in are all inspected before they are covered. Nothing gets closed up ahead of its inspection, whatever the programme pressure.

Weather

Until each level is dried in, heavy rain moves the programme. We would rather lose a day than build wet, and on a multi-level building that sequencing is planned.

Neighbours and the public

A multi-unit site is visible and audible to a whole neighbourhood for a long time. Working within permitted hours and keeping the site clean is part of the job.

Certificates

Nobody moves in before the certificate of occupancy. On a phased scheme these can come building by building, which is often what makes phasing worthwhile.

Why the builder matters on multi-family

Only claims we can stand behind. Everything below is either a matter of public record or visible in the work shown on this page.

Licensed, bonded and insured

Elbaz Construction is a licensed general contractor, CBC1265280. Ground-up work is fully permitted and permits are pulled in the company name.

Feasibility before design

What the parcel will carry is established against the actual zoning and the actual utility capacity before drawings are produced.

Design and construction together

The drawings, the permit set and the build are handled by the same company, so the scheme that is approved is the one that gets built.

Stacking discipline from the first sketch

Wet rooms stack and risers run straight because the plan was drawn that way, not because it was patched later.

Rated assemblies built to the tested detail

Separation between dwellings is built to the assembly that was tested, with every penetration firestopped as it is made.

Engineering coordinated in-house

Structural, civil and MEP are coordinated into one set, including the wind criteria that apply in South Florida.

Local knowledge

Zoning, parking, impact fees and approval routes differ sharply across the 104 municipalities of Miami-Dade, Broward and Palm Beach.

Permits closed out

Every permit is signed off and closed. Open permits follow a property and surface at sale or refinance.

Questions, by stage

Filter to the part of the job you are thinking about.

How many units can I build on my site?Before starting

That is a zoning question answered against the actual parcel, and parking frequently limits it before density does. Setbacks, height and coverage all bind at once. It is the first thing we establish, because designing to the wrong number wastes everything after it.

Do I need a rezoning?Before starting

Sometimes. If the scheme fits the existing designation you may need only a building permit, or site plan approval. If it does not, a rezoning or variance is a separate public process with its own calendar and no guaranteed outcome - and you should know which situation you are in before spending on design.

What is the difference between townhomes and stacked flats?Before starting

Townhomes sit side by side with a rated party wall and no common circulation. Stacked flats sit above one another off a common corridor, which gets you far more units per acre but brings corridors, stairs, lifts, and sound between floors as primary design concerns.

Why do bathrooms have to line up between floors?Design

So the drainage, supply and ventilation can run in continuous vertical risers. A plan where wet rooms wander between floors is buildable only at considerable cost, and it is the most common reason an attractive early layout has to be reworked.

How do you stop sound travelling between units?Design

With designed assemblies rather than added insulation. Between stacked units that means a floor build-up with a resilient layer and often a resiliently mounted ceiling below. It is a design decision made early - it cannot sensibly be added afterwards.

Do the units need to be accessible?Design

Covered multi-family buildings carry accessibility design requirements for dwellings and common areas. They shape the plan - levels, thresholds, clear widths, door hardware, bathroom dimensions - so they are designed in from the beginning rather than retrofitted.

What is the biggest early risk?Planning

Utility capacity, usually. A parcel can be perfectly zoned for your unit count and still have a connection point that cannot carry it. Confirming water, sewer, power and stormwater capacity early is not a formality.

What are impact fees?Planning

Charges levied by the jurisdiction to fund the public infrastructure your development draws on. On multi-family they are substantial and payable before permit issue, so they belong in the feasibility model from the beginning rather than appearing near the end.

Does the flood zone matter?Planning

Frequently yes. It affects the required finished floor level and what may be built below it, and it can reshape the site plan and the parking strategy. It is established at feasibility, not during design.

What gets inspected on a multi-family build?Permits

Considerably more than a house. Foundations, structure at each level, rated assemblies, firestopping, rough-in across every trade, accessibility, and finals - and each one gates the work that follows it.

Can we get a certificate of occupancy building by building?Permits

Often yes on a phased scheme, and it is frequently what makes phasing worth doing - earlier buildings can be occupied and generating revenue while later ones are still under construction.

How long does it take?Construction

Construction runs in many months. Feasibility, entitlement and permitting frequently take as long again beforehand. We will give you a realistic programme for both once we know the parcel and the approval route.

Why does nothing seem to happen at the start?Construction

Because the first phase is largely underground - clearing, grading, drainage and utilities. It consumes real programme time and produces nothing visible. Once the structure starts, progress becomes very fast.

What is the cost per unit?Cost

Not a number anyone can honestly give you before the site is understood. Building over parking, a rezoning, utility upgrades, flood requirements and unit mix all move it substantially - and the site frequently moves it more than the building does.

What makes multi-family more expensive than housing?Cost

The things between the dwellings: rated separation, acoustic assemblies, common circulation, lifts, accessibility, and per-unit metering. Then site infrastructure and impact fees, which have no equivalent on a single house.

What do we get at handover?Completion

Certificates of occupancy, closed permits, product approvals for the envelope, and the operation and maintenance documentation for the common systems - all of which matter for the association and at refinance or sale.

What ongoing maintenance should we budget for?Maintenance

Common areas, roofs, the envelope, lifts where present, and the parking structure if there is one. A multi-family building has significant shared infrastructure, and reserve planning for it should start before handover.

What do residents complain about most?Maintenance

Sound between units, almost always - which is exactly why the separation assemblies are worth spending real money on at design stage rather than meeting the minimum and hearing about it for twenty years.

Client experience

What clients say, in their own words

Live Google reviews for Elbaz Construction, pulled straight from our Google Business Profile — not retyped, not edited and not selected by us.

Reviews are served live by the site's own Google Reviews plugin and update as new ones are posted. Nothing here is retyped, shortened or re-attributed.

Project files

Single-family homes, shown for the building language.

The photos here are single-family Elbaz builds, shown for the structure, finishes and site work a multi-family project shares. These are single-family homes, one mid-build and four finished, shown for the exterior detail that carries over.

2Projects shown
8Photos
1Site videos
PROJECT 01

A single-family house in its finish stage

This is a single-family house, not a multi-family building. It is shown in the finish stage: stucco and a tall window wall are in place, a rooftop terrace is open, and a trailer and van sit on a sandy lot. Wall, window and roof-edge details here are the same ones a larger building repeats.

Scope of work

  • Concrete block and stucco exterior
  • Tall window wall installation
  • Flat roof with terrace opening
  • Cantilevered upper volume
  • Window protection during construction
  • Site cleanup and material staging

Materials & finishes

StuccoBlack window framesFlat roof membraneWindow protectionConcrete blockSandy fill

What to look for in the photos

Look at the roof edge and the terrace opening. On any multi-level building these are where leaks start, so waterproofing and flashing are detailed early.

Elbaz Construction project photo · 4 photos

PROJECT 02

Four finished two-story homes, several jobs

A collection of four two-story single-family homes from several Elbaz jobs. Three are modern white houses with stairs, balconies and palms. One is a Mediterranean style with an arched entry and tile roof. None is a multi-family building.

Scope of work

  • Exterior stairs and railings
  • Balcony and upper-level framing
  • Stucco wall finish
  • Arched entry and tile roof
  • Paver walkway and hedge plantings

Materials & finishes

White stuccoBlack railingsBarrel tile roofConcrete paversPalm and hedge plantings

What to look for in the photos

Study how stairs, balconies and entries are handled. In a multi-family building these repeat across floors and units, so a detail that works once must work dozens of times.

Collection: photos from several Elbaz Construction jobs · 4 photos

In motion

One lot, from the street to the pool.

A single drone pass over a finished single-family home, shown for how a site and building relate.

High wide view down to the rear pool

Budget and schedule

Where a multi-family build spends.

Typical shares and typical sequence for a small ground-up multi-family building. Unit count, type and parcel move both.

Where a typical multi-family budget goes

100%OF BUDGET
  • Site work and utilities11%
  • Foundations and structure24%
  • Envelope, roof, windows15%
  • Fire and life safety6%
  • Plumbing, electrical, HVAC20%
  • Unit interiors18%
  • Permits, fees, design6%

Typical shares only; building type, unit count and fire protection move every slice.

A multi-family building, in weeks

Feasibility & entitlement
Design & permit set
Permitting
Site work & utilities
Foundations & structure
Envelope & fire separations
MEP & interiors
Interiors
Inspections & C.O.
Week 0Week 60Week 120

Feasibility and permitting take a large share of the calendar before the site shows visible progress.

How it comes together

Four drawings for a larger building.

The parts of a multi-family project that differ most from a house.

NEW HOME, IN ORDER1SITE+ PAD2FOUNDATION3CBS SHELL+ TIE BEAM4ROOFDRY-IN5MEPROUGH6FINISHES+ C.O.

Six stages, parcel to C.O.

Feasibility, design, permits, site work, structure and interiors, then inspections and the certificate of occupancy. Multi-family adds fire separations and shared utilities at each step.

TIE BEAMFILLED CELL + REBAR

Block under party walls

Reinforced block and tie beams carry floors and roofs. Walls between units add fire-rated and sound-rated layers on top of the structure.

BFEFINISHED FLOORFILL PADEXISTING GRADEFLOOR SET ABOVE FLOOD ELEVATION

Pad above base flood

Fill and finished floor elevation come from the survey and the flood map. On a larger footprint, drainage and fill volume deserve extra care.

36 in MIN. ROUTERAMP 1:12 MAXENTRYACCESSIBLE ROUTE: PARKING TO DOOR

A ramp that works

An accessible route from parking to the entry uses a gentle slope and landings. Larger buildings with shared entries often need one.

Scope planner

Scope a small multi-family build.

Choose the building type, size and site. We show likely trades, permits and added weeks on site.

Building type?
How many buildings?
Site condition?
Accessible route?

More questions

Fire, utilities and neighbors.

Specifics that matter once more than one household is under the same roof.

Ask us directly
How are fire-rated walls and floors between units built?

They are tested assemblies, not custom walls: a listed combination of framing, drywall layers, insulation and fire-stopping at every penetration. The inspector checks that pipes, wires and ducts are sealed to match the listing. Gaps, patched holes and substituted materials fail, so we photograph each rated wall before it is covered.

Will the building need fire sprinklers?

That depends on the occupancy type, size, height and the local fire marshal's rules under the Florida Fire Prevention Code. Many multi-family buildings require them, and some smaller ones do not. We confirm it during feasibility because sprinklers affect water service size, riser rooms, ceilings and cost.

How is each unit metered for water and power?

Utility companies set the rules, and the choice affects the design from the start. Individual meters per unit need meter rooms and clear routes, while a master meter may be simpler but pushes billing to the owner. We ask early what each utility requires, because relocating a meter bank late is expensive.

How does parking change the plan?

Municipal codes set a minimum number of spaces per unit, and the count often decides how many units fit. Spaces also take area for stormwater, so drive lanes, turning radii and drainage are drawn together. We check the parking requirement alongside zoning in the first feasibility pass.

How does the hurricane zone affect a larger building?

In HVHZ counties every roof, window, door and cladding product needs a Notice of Acceptance, and structural design uses higher wind loads. Elsewhere the Florida Building Code wind speeds still apply. In either case the engineer designs lateral resistance for the whole building, not unit by unit, and the details are inspected.

Why do balconies and roofs get so much attention?

They are the most common sources of water entry and later disputes. Waterproofing, flashing, slopes to drains and scuppers are specified before framing. Every unit repeats the detail, so a small flaw becomes a building-wide problem. We inspect and photograph each stage before it is closed up.

How do construction draws line up with inspections?

Lenders usually release funds against completed stages, and they rely on passed municipal inspections plus their own inspector. We schedule our work so a stage ends with a passed inspection and a clean lien waiver. That keeps payments on time and protects you from paying twice for work in progress.

How do you manage noise and traffic around neighbors?

We follow the local work-hour rules, schedule large deliveries away from peak traffic and keep the site tidy. Neighbors get a contact number, and we respond to complaints quickly. Dust control, street sweeping and protected curbs matter more on a larger building site than on a single house.

Start here

Book the site visit

Tell us where the parcel is and roughly what you are trying to achieve on it. Feasibility is the useful first conversation, not design.

What happens next

  1. We read it properly and come back to you, usually the same or next working day.
  2. A short call to understand the property and what is driving the project.
  3. A feasibility review - we check zoning, density, parking and whether utilities can actually serve the scheme.
  4. A written, itemised proposal with the scope set out, including how unknowns are handled.
  5. If you go ahead, we prepare and file any permit before work starts.
Preferred contact method

We use your details only to respond to this enquiry. No lists, no resale.

Thanks — that came through.

Your details are with the Elbaz Construction team and we will come back to you, usually the same or next working day. If it is urgent, call (754) 236-0675.

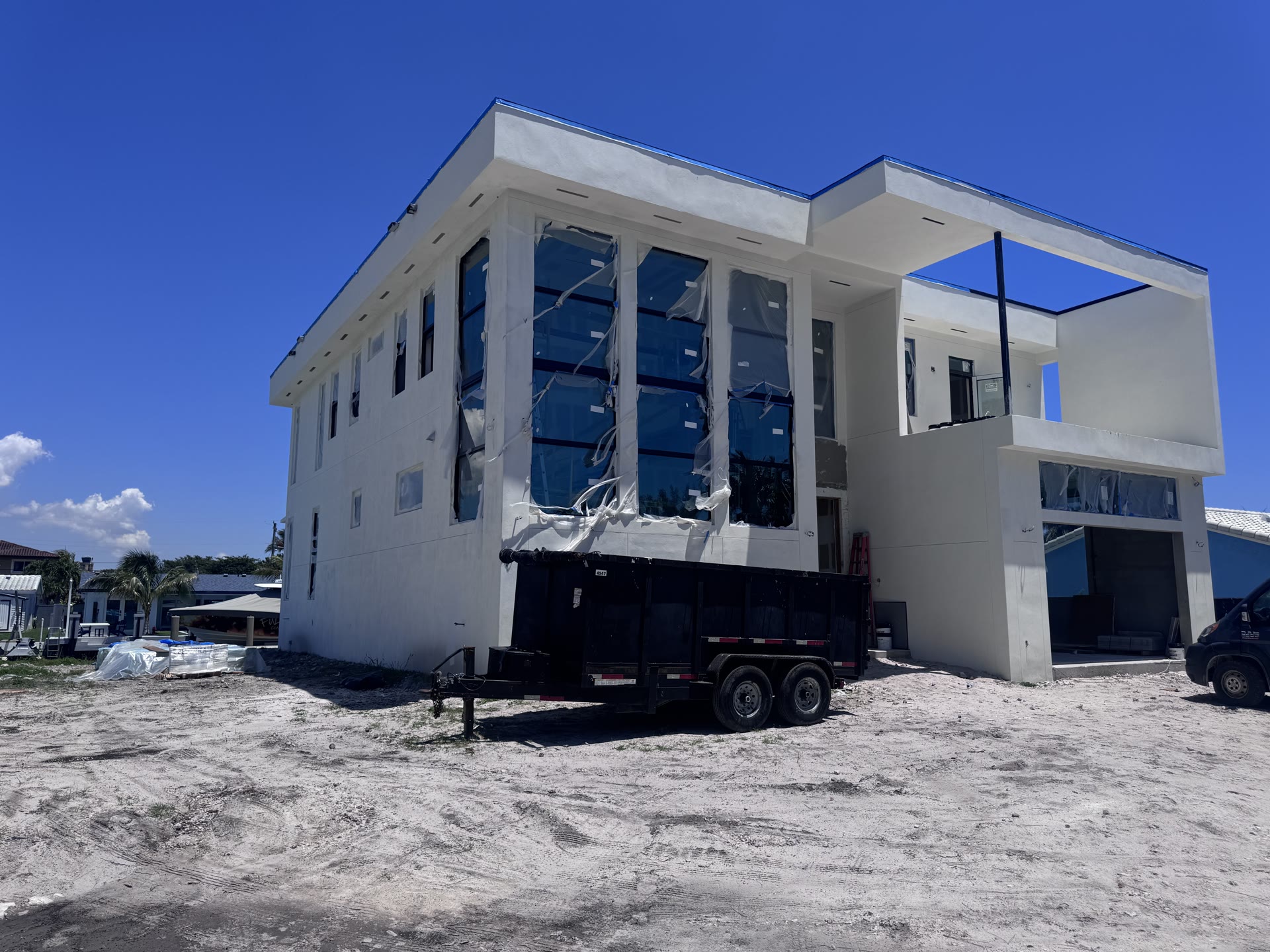

Two-storey ground-up build under construction, structure and glazing in place, seen from the lot

Start with the parcel, not the unit count.

What the zoning permits and what the utilities can carry decide the scheme. Every hour spent designing before those are answered is an hour at risk.
