Asphalt shingle roof field with ridge and hip detail

A roof is an
assembly, not
a shingle.

What keeps water out is the deck, the fasteners, the underlayment and the flashing. The shingle is the wear layer on top of all of it. We build the whole assembly to the approved detail and have it inspected at every stage that requires it.

  • Licensed, bonded & insured · CBC1265280
  • 104 municipalities across 3 counties
  • Design-build: permitting & construction in-house

Miami-Dade · Broward & Palm Beach Counties

Scroll
A-00Architectural
SHEET A-00 / ROOF INDEX · 12 FRAMES

Recent work

Check out our roofing projects.

Tear-off, decking, underlayment, shingle field, hips, ridges and penetrations across South Florida roofs. Select any frame to open it.

G-01General
SHEET G-01 / SHINGLE ROOFING
01

The service, defined

Everything above the ceiling, replaced as one system.

Shingle roofing is the removal of the existing covering down to the deck, the repair or replacement of that deck, and the installation of a complete new assembly — underlayment, drip edge, flashing, valley treatment, field shingles, hip and ridge, and ventilation.

It serves owners whose roof has reached the end of its service life, has storm damage, or is failing an insurance inspection. Asphalt shingle remains the most common residential covering in South Florida because it is economical, repairable, and available in profiles approved for high-wind installation.

Asphalt shingle roof field with ridge and hip detail
REFShingle field with hip and ridge detail on a completed roof.

The Florida Building Code treats roofing as a wind-resistance problem first and a weather covering second. Miami-Dade and Broward sit inside the High-Velocity Hurricane Zone, so shingles, underlayment and fasteners all need approval for the pressures at your address, and the roof deck itself often has to be refastened to current standards during a replacement — work that is invisible the day after it is finished and decisive the day a storm arrives.

What is included

Scope
Tear-off and disposal, deck inspection and repair, underlayment, drip edge, flashing, valleys, field shingles, hip and ridge, ventilation, inspections and closeout
Delivered by
One licensed general contractor — CBC1265280
Region
Miami-Dade, Broward and Palm Beach counties
Assembly
Sheathing · secondary water barrier · underlayment · metal edge · valley and penetration flashing · shingle field · hip and ridge
Also delivered
Tile and metal systems where the roof or the association calls for them
A-01Architectural
SHEET A-01 / SCOPE OF WORKS · 11 ITEMS
02

Scope index

Everything a roof replacement actually contains.

Eleven items, four phases. Half of them are covered by the finished surface and are the half that decides how long the roof lasts.

Asphalt shingle roof field with ridge and hip detail

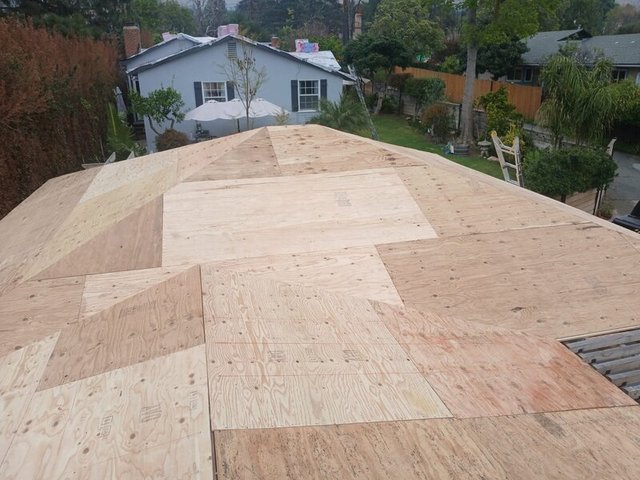

REFRoof deck exposed after tear-off, before underlayment.
01 / Pre-install

Inspection and assessment

We look at the existing covering, the deck where it can be seen, the penetrations, the valleys and the ventilation, and identify what is actually failing rather than what is simply old.

A-02Architectural
SHEET A-02 / PROJECT 01 · 09 FRAMES
PROJECT 01

Shingle Roof Replacement

Tear-off, deck preparation and complete new shingle assembly

A replacement documented across the stages that matter: the deck once it is open, the underlayment before it is covered, and the finished field with its hips, ridges and penetrations.

Select any frame to open it full size.

A-03Architectural
SHEET A-03 / SPECIFICATION · PROJECT 01
03

Specification

Shingle Roof Replacement

Recorded from the photography only. Product brand, cost, schedule, address, client and wind-rating figures are not documented in the source material and are not stated.

Project type
Full replacement of an asphalt shingle roof, tear-off to deck
Roof form
Hipped roof with multiple planes, valleys and penetrations
Stage documented
Deck exposed · underlayment installed · field complete
Deck
Sheathing inspected with the covering removed; damaged panels replaced before anything is laid over it
Underlayment
Full-coverage underlayment fastened to the deck before the covering, visible in the second and third frames
Visible detailing
Straight course lines · capped hips and ridge · flashed penetrations and vents · consistent exposure across planes
Functional improvement
A complete new assembly rather than a covering laid over an unknown deck
Stage documented
Complete
Asphalt shingle roof field with ridge and hip detail
REFUnderlayment fastened before the shingle field goes on.
A-04Architectural
SHEET A-04 / MATERIAL AND DESIGN LANGUAGE
04

Design and material language

Five decisions that set how the roof performs.

What the assembly is made of, what appears on the documented roofs, and what the alternatives actually change.

Asphalt shingle roof field with ridge and hip detail
DETShingle courses running to a hip.
Asphalt shingle roof field with ridge and hip detail
DETPenetrations flashed into the shingle field.
M-01

Shingle type

Architectural or three-tab

Used on these roofs. Architectural (dimensional) shingles appear across the documented roofs. They are heavier, read with more depth and shadow, and are generally the product available in higher wind ratings.

Other options. Three-tab is thinner, flatter and cheaper, and is now uncommon on replacements here because of wind-rating requirements. Tile and standing-seam metal are the other two systems we install.

M-02

Underlayment

The layer that actually keeps water out

Used on these roofs. Full-coverage underlayment fastened to the deck before the covering, visible in the documented sequence.

Other options. Self-adhered membranes cost more and perform better at the eave, in valleys and on low slopes. In the HVHZ a secondary water barrier is a code requirement, not an upgrade.

M-03

Fastening

The part the code cares about most

Used on these roofs. Nail type, length, count and placement are specified by the approved assembly, and the high-wind nailing pattern uses more fasteners in a defined position.

Other options. A shingle nailed high or with too few fasteners looks identical from the ground and fails at a fraction of the rated pressure. This is where inspection matters.

M-04

Flashing

Where roofs leak

Used on these roofs. Wall and step flashing, valley treatment and penetration boots appear throughout the documented work. These are the locations where nearly every real leak starts.

Other options. Reusing old flashing to save cost is a false economy: it is buried under the new covering and cannot be replaced later without disturbing it.

M-05

Ventilation

What extends the life of everything else

Used on these roofs. Ridge and roof vents are set into the documented assemblies. Ventilation moves heat and moisture out of the roof space.

Other options. Intake and exhaust have to balance. Adding exhaust vents without adequate soffit intake can make attic conditions worse rather than better.

On what is shown. Every photograph on this page is real Elbaz Construction roofing work. The alternative systems described are named for comparison only and are not claimed to be what is pictured.

G-02General
SHEET G-02 / PROCESS · 10 STAGES
05

Process

Ten stages, in order.

Weather governs roofing more than any other trade. Tear-off only starts when the forecast allows the deck to be dried in the same day, which is why we will not promise a fixed calendar date months out.

01
Inspection

Assess the covering, deck, flashing, valleys and ventilation.

02
Proposal

Scope, assembly and approvals set out in writing.

03
Permitting

Application, product approvals and required affidavits submitted.

04
Protection

Landscape, pool, driveway and equipment protected; disposal sited.

05
Tear-off

Covering and fasteners removed down to the deck.

06
Deck repair

Sheathing inspected, repaired and refastened to code.

07
Dry-in

Secondary water barrier and underlayment installed and inspected.

08
Flashing

Edge metal, valleys, wall flashing and penetration boots.

09
Shingle field

Field, hips and ridge laid to the approved nailing pattern.

10
Inspection and closeout

Final inspection, magnetic sweep, documents handed over.

P-01Permitting
SHEET P-01 / PERMITTING AND CODE BRIEF
06

Technical brief

Why a roof permit is stricter here than almost anywhere.

Roofing in South Florida is one of the most tightly regulated residential activities there is. Here is what the building department actually requires and inspects.

Asphalt shingle roof field with ridge and hip detail

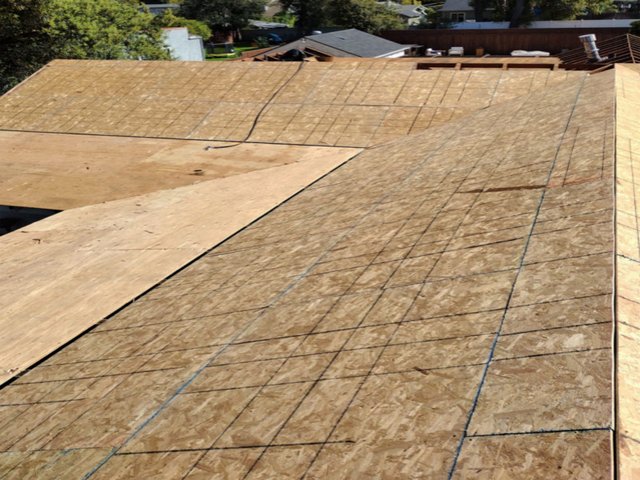

PDeck exposed and available for inspection.
Asphalt shingle roof field with ridge and hip detail
PDry-in stage, inspected before the covering.
P-01

A permit is always required

Roof replacement is a permitted activity everywhere in South Florida. Work done without one can affect insurance and will surface at sale.

P-02

High-Velocity Hurricane Zone

Miami-Dade and Broward sit inside the HVHZ, which has its own roofing provisions, its own required affidavits and stricter product approval. Palm Beach follows the standard code but remains a high-wind region.

P-03

Product approval

Shingles, underlayment and accessories must carry current approval — a Miami-Dade Notice of Acceptance or Florida Product Approval — for the assembly and the pressures at your address.

P-04

Deck attachment

On a replacement, the roof deck generally has to be refastened to current standards and inspected before dry-in. This is often the single largest unexpected item on an older house.

P-05

Secondary water barrier

Required in the HVHZ. It is the layer that limits water entry if the covering is lost during a storm, and it is inspected before it is covered.

P-06

Inspection sequence

Typically deck and renail, then dry-in, then final. Each must pass before the next stage covers it — which is the reason roofing cannot be compressed into one visit.

P-07

Twenty-five percent rule

Where more than a quarter of a roof section is repaired or replaced within a twelve-month period, the code can require the whole section to be brought to current standards. It is worth knowing before choosing a partial repair.

P-08

Wind mitigation and insurance

A completed permitted roof supports a wind mitigation inspection, which is what insurers use. We do not promise a premium outcome — that is between you, the inspector and your carrier.

P-09

Closeout documentation

You should end up holding the closed permit, the product approvals, the manufacturer warranty registration and the workmanship warranty.

Disclaimer. Requirements, fees and review times are set by your municipality and change. Nothing here is a legal opinion or a guarantee of approval, timing or insurance outcome — the building department having jurisdiction over your address is the authority.

S-01Structural
SHEET S-01 / ROOF ASSEMBLY
07

Assembly

Section through the roof assembly.

An indicative section through a shingle roof — the layers in order, and the two places where nearly every failure actually begins.

Indicative section through an asphalt shingle roof assemblyRaking section showing, from the top down: shingle courses with their exposure and nail line, underlayment, secondary water barrier, roof sheathing fastened to the rafter, and the eave with drip edge and ventilation intake below.01020304nail line0506Indicative section — not a construction drawing

Key

01
Shingle courses and exposure
02
Underlayment
03
Secondary water barrier (HVHZ)
04
Sheathing, refastened to code
05
Drip edge and eave metal
06
Soffit intake ventilation
S-01

The nail line

Every shingle has a defined nailing zone. Nails placed above it hold on one layer instead of two and pull through at a fraction of the rated pressure. From the ground the roof looks identical either way.

S-02

Sequence at the eave

Drip edge, underlayment and starter course have a required order. Getting the order wrong lets water run behind the metal instead of over it, and it cannot be seen once the field is on.

S-03

Valleys and penetrations

These are where leaks actually start. A field of shingles rarely fails on its own; the junctions do, which is why flashing is replaced rather than reused.

S-04

Balanced ventilation

Exhaust at the ridge needs matching intake at the soffit. Exhaust alone pulls conditioned air out of the house instead of moving air through the roof space.

Q-01Quality
SHEET Q-01 / PERFORMANCE AND QUALITY
08

Performance and quality

What we hold ourselves to.

No wind rating, insurance saving or product performance figure is claimed on this page. Those belong to the specific approved assembly installed and to your carrier.

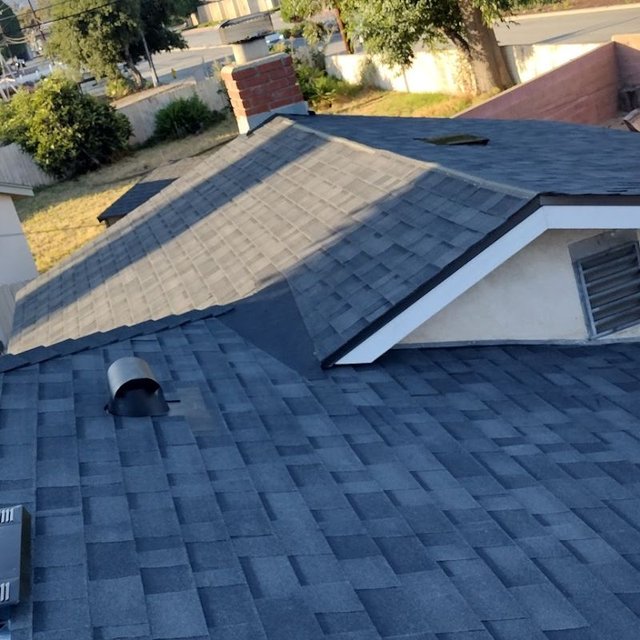

Asphalt shingle roof field with ridge and hip detail
QRoof plane meeting a wall with flashing in place.
Asphalt shingle roof field with ridge and hip detail
QRidge line and capping on a finished roof.
Tear-off to deck
The covering comes off. Roofing over an existing layer hides the deck and shortens the life of the new roof.
Deck condition
Sheathing is inspected with the deck open, damaged panels are replaced, and refastening is done to current code.
Approved assembly
Shingle, underlayment and fasteners are installed as an approved system rather than mixed by convenience.
Nailing pattern
Fastener count, type and placement follow the approval, including the high-wind pattern where required.
New flashing
Valley, wall, step and penetration flashing is replaced, not reused. It is buried and cannot be revisited.
Ventilation balance
Intake and exhaust are assessed together rather than vents simply added at the ridge.
Site protection and cleanup
Landscape and pool protected, magnetic sweep for nails, and the property left clean.
Inspection record
Every required inspection is called and passed. The closed permit is the record that the assembly was reviewed.
C-01Cost
SHEET C-01 / COST AND SCHEDULE VARIABLES · 13
09

Cost and timeline

The thirteen things a real number is built from.

We do not publish a price per square. Deck condition is the largest unknown on any replacement and it cannot be seen until tear-off. Our proposals state clearly what is included and how deck repair is priced, so there are no invented surprises.

Asphalt shingle roof field with ridge and hip detail
CCompleted roof over a South Florida residence.
Asphalt shingle roof field with ridge and hip detail
CShingle field with hip and ridge.
#VariableWhy it moves the number
01Roof area and pitchArea drives material; pitch drives safety, access and labour rate.
02Roof complexityHips, valleys, dormers and penetrations all take longer per square foot than a simple plane.
03Number of existing layersEvery layer removed is disposal weight and labour.
04Deck conditionRotten or delaminated sheathing found at tear-off. The largest genuine unknown on the job.
05Deck refasteningRenailing to current code is commonly required on older houses and is inspected.
06Shingle specificationProduct line and wind rating within the architectural category vary considerably.
07Underlayment specificationStandard versus self-adhered, and how much of the roof gets the upgraded treatment.
08Flashing and penetrationsHow many chimneys, skylights, vents and wall junctions the roof actually has.
09Ventilation workAdding or correcting intake and exhaust as part of the replacement.
10Access and stagingWhere disposal can sit, how far material must be carried, and whether a lift or crane is needed.
11Protection requirementsPools, screens, pavers and mature planting all need protecting during tear-off.
12Permit and inspectionsMunicipal fees and the inspection sequence itself.
13Weather and seasonStorm season compresses schedules and tightens material and labour availability across the region.
I-01Information
SHEET I-01 / QUESTION INDEX · 15
10

Question index

Straight answers about shingle roofing.

Fifteen questions across lifespan, replacement triggers, materials, code, permits, insurance, cost and storm season.

01 / Lifespan

How long does a shingle roof last in South Florida?

Less than the number on the packet. Manufacturer lifespans are laboratory figures; sun, heat and UV here are harsh, and roofs commonly reach practical end of life well before the printed warranty period. Ventilation and installation quality make more difference to the real number than the brand does.

A-06Architectural
SHEET A-06 / CONSTRUCTION STUDY
Construction study

Four things worth looking for.

Asphalt shingle roof field with ridge and hip detail
STUDYUnderlayment fastened to the deck before the covering.

These frames are real Elbaz Construction roofing work in South Florida. AI-generated frames and images naming other roofing companies were found in the source folder and excluded — none appears on this page.

Observations

01
The deck is visible
There is a stage where the sheathing is completely exposed. That is the only opportunity to assess and repair it, and a roof that skips it is a roof laid over an unknown.
02
Underlayment before covering
The dry-in layer goes on and gets inspected before any shingle. In the HVHZ this stage includes the secondary water barrier.
03
Consistent course lines
Straight, evenly spaced courses across every plane indicate the exposure was set and held. Wandering courses usually mean the nailing zone wandered too.
04
Capped hips and ridges
Hips and ridges are finished with matching components rather than field shingles bent over the line, which is where wind gets under a roof first.
G-03General
SHEET G-03 / DELIVERY AND CREDENTIALS
11

Credentials and delivery

Six verifiable reasons, and no badges.

Nothing here is an award or a membership we cannot substantiate. The licence number is public and checkable.

Asphalt shingle roof field with ridge and hip detail
REFCompleted shingle roof on a South Florida residence.
01

Licensed general contractor

CBC1265280 — certified building contractor, bonded and insured, permitted and inspected on every roof.

02

Tear-off as standard

We remove the existing covering rather than laying over it, because the deck is the part that decides how long the new roof lasts.

03

Approved assemblies

Shingle, underlayment and fasteners installed as a matched approved system with current documentation for your jurisdiction.

04

Deck work included honestly

Refastening and sheathing repair are priced openly and photographed as found, rather than discovered as an argument later.

05

Local to the region

Miami-Dade, Broward and Palm Beach — including the HVHZ requirements that apply to two of those three counties.

06

Documentation handed over

Closed permit, product approvals and warranty registration handed over as a set, which is what a future buyer or insurer asks for.

I-02Information
SHEET I-02 / CLIENT RECORD
12

Google reviews

In their words, unedited.

Reviews are quoted verbatim from the Elbaz Construction Google Business Profile. They describe the company as a whole — none refers specifically to the roofing work documented above.

★★★★★

“After calling around and dealing with a bunch of unexperienced companies I found Elbaz construction and gave them a call. Just from the ease of communication and friendly talk I’ve had with the owner I knew this was going to be the company I was going to hire. Great service, great communication, and amazing work.”

Itzick Manasherov · Google review

★★★★★

Great service - Great quality - very quick - very professional !! Highly recommended!

Adir Davidov

★★★★★

These people are super professional super honest super Fast !! Don't hesitate to Rent their service! They are number one!!

carmit cohen

★★★★★

They did a great job in my house for some work that needed to be completed, and I am extremely happy with the result.

Mia Zafrani

★★★★★

Their work was absolutely superb, they did a fantastic job with my house renovation!! Definitely recommend

Sophie Brito

G-04General
SHEET G-04 / ENQUIRY
13

Start here

Book the roof inspection.

Tell us the age of the roof and what you are seeing. We will come and look at it properly, including the attic where we can get to it.

Asphalt shingle roof field with ridge and hip detail
REFCompleted shingle field with ridge and hip detail.

What happens next

01
We call or email within one business day, Sunday to Friday.
02
A roof inspection: covering, deck where visible, flashing, valleys, penetrations and ventilation.
03
A written scope stating the assembly, how deck repair is priced, and a fixed proposal.
Useful to have
The approximate age of the roof, any leak history, and any notice your insurer has sent you about the roof.
Preferred contact method

We use your details only to respond to this enquiry. No lists, no resale.

Thanks — that came through.

Your details are with the Elbaz Construction team and we will come back to you, usually the same or next working day. If it is urgent, call (754) 236-0675.

G-05General
SHEET G-05 / END OF SET

Take it back to the deck.
Then build it once.

Inspection, permitting, tear-off, deck repair and a complete new assembly under one licensed general contractor across Miami-Dade, Broward and Palm Beach.

Asphalt shingle roof field with ridge and hip detail
ENDShingle courses running to a hip on a completed roof.
