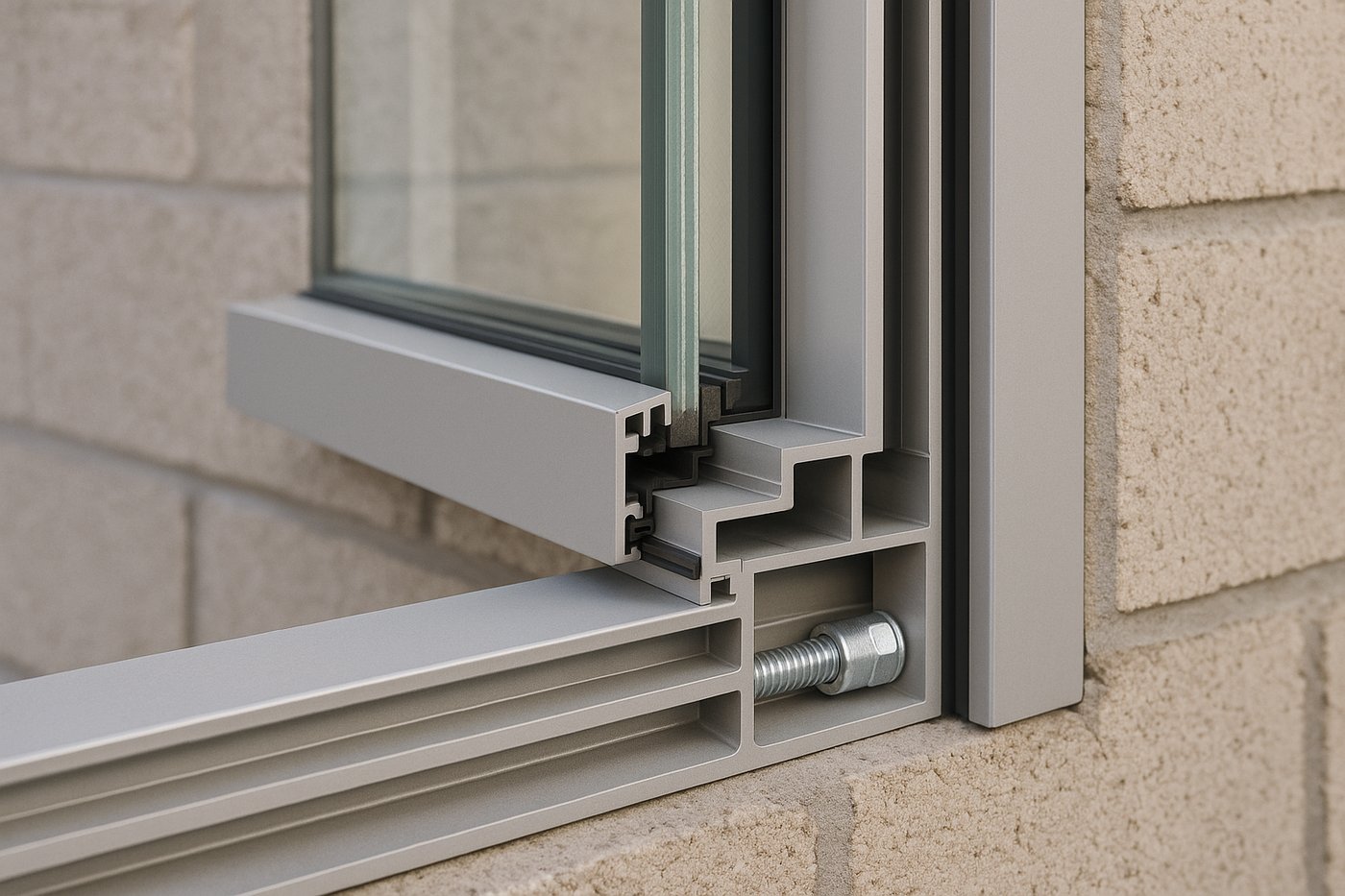

Cutaway of an impact-rated window showing the laminated interlayer and frame anchorage
Cutaway of an impact-rated window showing the laminated interlayer and frame anchorage.

The service

An NOA is a document
about a system.

A Notice of Acceptance is Miami-Dade product approval: evidence that a specific product, in a specific configuration, with specified anchors at specified spacing, has been tested and accepted for High-Velocity Hurricane Zone use.

The part people underestimate is that it constrains installation as much as selection. Substrate type, buck detail, fastener, embedment and spacing are all part of the approval. Install the right window the wrong way and it is not an approved assembly any more.

  • HVHZ is two counties

    Miami-Dade and Broward. Palm Beach is not in the HVHZ and uses the statewide Florida Product Approval framework.

  • The anchorage is the approval

    Fastener type, spacing and embedment are specified. Substituting them invalidates it.

  • Submittals fail on completeness

    Most correction cycles are missing documents, not wrong products.

Talk through your products

Scope

What the compliance service covers

Turning a product selection into a submittal a plans examiner will accept first time.

Corner zones catch people out

Design pressures at the corners and edges of a building are higher than in the field. A product that satisfies the field pressure may not satisfy the corner, and the schedule has to be opening-by-opening rather than one number for the whole house.

01

Product selection review

  • Confirming each product has current approval valid for the jurisdiction
  • Checking configuration, size and rating against what is actually specified
  • Confirming design pressures required for the opening and its zone
  • Identifying products whose approval has lapsed or been superseded
02

Design pressure and zoning

  • Design pressures established for the building height, exposure and risk category
  • Corner and edge zone pressures distinguished from field pressures
  • Opening-by-opening schedule matching product rating to required pressure
  • Glazing requirements for wind-borne debris where applicable
03

Anchorage and substrate

  • Anchor type, size, spacing and embedment taken from the approval document
  • Substrate confirmed — masonry, concrete, wood buck or metal — for each opening
  • Buck detail and installation sequence documented
  • Engineering where a condition falls outside the approval’s scope
04

Submittal and review

  • Compiled submittal package with approvals, schedules and details
  • Filed with the authority having jurisdiction
  • Correction responses prepared and submitted by us
  • Coordination with inspection at installation

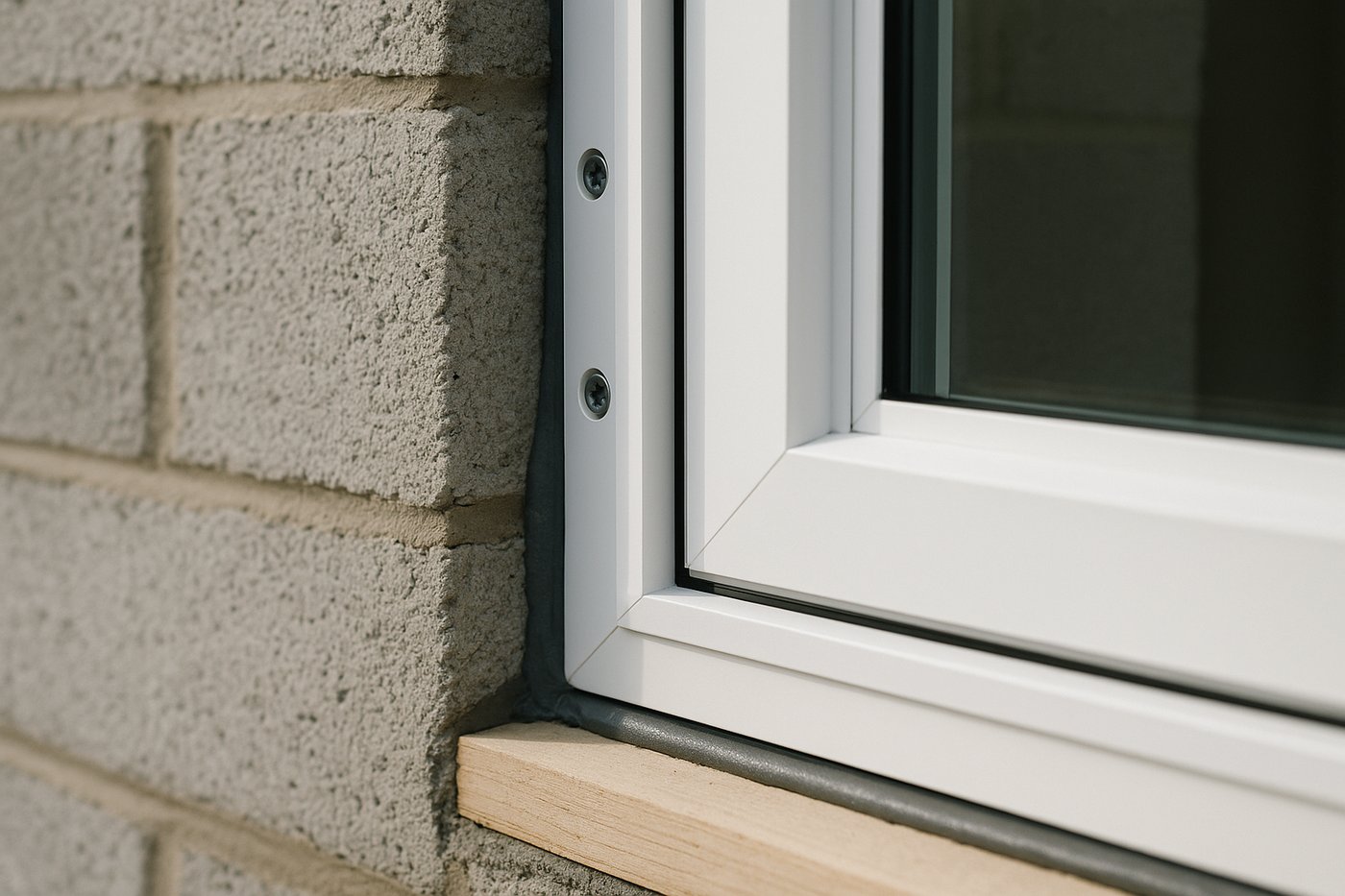

Window frame anchored into a masonry opening with fixings at specified spacing
Window frame anchored into a masonry opening with fixings at specified spacing.

Stills from the two completed units on this page. They illustrate the stages; they are not photographs of the stage named beside them.

How it runs

Five stages,
one submittal

Compliance work is document work. It is done properly once, or repeatedly in corrections.

  1. 01

    Opening schedule

    Every opening measured and recorded with its location, size and exposure.

  2. 02

    Design pressures

    Established for the building and each opening zone, rather than assumed from a single figure.

  3. 03

    Product matching

    Each opening matched to a product whose approval covers that size, configuration and pressure.

  4. 04

    Anchorage detailing

    Substrate confirmed and anchor schedule taken from the approval, with engineering where a condition falls outside it.

  5. 05

    Submittal and corrections

    Package filed, corrections answered, and installation coordinated with inspection.

Approvals

Which framework
applies to you.

Miami-Dade and Broward counties are the High-Velocity Hurricane Zone. Products installed there require a Miami-Dade Notice of Acceptance, or in Broward a Broward NOA or an accepted Miami-Dade NOA.

Palm Beach County is not in the HVHZ. It falls under the statewide Florida Product Approval system and the Wind-Borne Debris Region provisions, which is a different set of documents for the same purpose.

Design wind speeds also differ across the region — roughly 175 mph in Miami-Dade and 170 mph in Broward for standard residential risk category, three-second gust. This is why a product that is perfectly acceptable in another part of Florida may not be acceptable here.

INFILLED VEHICLE OPENINGBATHKITCHENLIVING / SLEEPINGENTRY

Simplified sketch, for explanation only. It is not a permit drawing and not a plan of either project shown on this page.

From first call to closeout

  • Jurisdiction determination

    HVHZ or statewide Florida Product Approval.

  • Opening survey

    Sizes, locations, substrate and exposure.

  • Design pressure calculation

    By zone, not a single building-wide figure.

  • Product approval verification

    Current, valid and covering the configuration used.

  • Anchorage schedule

    Taken from the approval for the actual substrate.

  • Engineering

    Where a condition falls outside the approval’s tested scope.

  • Submittal

    Filed with the authority having jurisdiction.

  • Corrections

    Answered by us.

  • Installation inspection

    Coordinated so what was approved is what is inspected.

An expired approval is a stopped job

Product approvals have expiry dates and get superseded. A submittal built on a lapsed NOA is rejected, and if it is discovered after installation the remedy is expensive. Verifying currency is a five-minute job at the right moment.

Nothing here is legal advice, and no approval outcome or review duration is promised. Requirements vary by municipality and by property.

Cost and schedule

What moves the number

Compliance cost is driven by the number of distinct conditions, not by the number of openings.

01

What moves the cost

  • Number of distinct conditions

    Twenty identical windows in one substrate is one condition. Six sizes across three substrates is six.

  • Substrate variety

    Masonry, concrete, wood buck and metal each have their own anchor schedules.

  • Whether products are already chosen

    Products selected without reference to approval documentation often have to be re-selected.

  • Engineering requirement

    Conditions outside an approval’s tested scope need engineered details.

  • Building height and exposure

    Both raise design pressures and can narrow the product field considerably.

  • Correction cycles

    The main avoidable cost, and the reason completeness is worth paying for.

02

What moves the schedule

  • Opening survey

    First, and everything depends on it.

  • Product verification

    Quick where products are current; slower where they are lapsed or superseded.

  • Engineering

    Where required, on the engineer’s schedule.

  • Review

    Set by the authority having jurisdiction.

  • Corrections

    Each cycle adds review time.

  • Product lead time

    Impact-rated units are made to order.

Illustrative diagram · not a photograph of a project

AS FOUND · GARAGEopen vehicle opening · bare slab · no envelopeCONVERTED · HABITABLEinfill wall · windows · entry · egress · insulated envelope · treated slab010203040506

What a submittal
has to prove.

Six things, and a package missing any one of them comes back with corrections.

01

The product is approved

A current Notice of Acceptance or Florida Product Approval, not expired and not superseded.

02

The configuration is covered

Approvals cover specific sizes and configurations. A larger unit than tested is not approved.

03

The rating meets the pressure

Opening by opening, with corner and edge zones distinguished from the field.

04

The substrate matches

Anchor schedules differ for masonry, concrete, wood buck and metal. The detail has to match what is actually there.

05

The anchors are as specified

Type, size, spacing and embedment exactly as the approval states. Substitution invalidates it.

06

The installation is detailed

Buck, sealant and flashing shown, so what gets inspected is what was approved.

Window frame anchored into a masonry opening with fixings at specified spacing
Reference image for this section.

What to expect

Paperwork now,
or rework later.

This is the least visible part of a project and the one most likely to stop it.

  • Front-loaded

    The work happens before anything is ordered or installed.

  • Product decisions get constrained

    Approval documentation sometimes rules out a product that was already chosen.

  • Engineering where needed

    Conditions outside a tested scope need a detail from an engineer, and that takes time.

  • Corrections are normal

    Even good submittals attract comments. Ours are answered promptly rather than queued.

  • Inspection alignment

    The installer is given the same anchor schedule the submittal used, so the inspection matches.

  • Records retained

    The approved package is handed over, because it is what evidences compliance later.

Questions

Ask the
awkward ones.

Six categories. Pick one and the answers change.

Not answered here?

(754) 236-0675

Sun-Fri 7am-7pm · Sat closed

A Notice of Acceptance — Miami-Dade County product approval documentation showing that a specific product, in a specific configuration, with specified anchorage, has been tested and accepted for High-Velocity Hurricane Zone use. Broward accepts its own NOAs or Miami-Dade ones.

Not an NOA. Palm Beach County is outside the HVHZ and uses the statewide Florida Product Approval system together with the Wind-Borne Debris Region provisions. Same purpose, different documentation.

Construction drawings and technical submittal documents laid out for review
Construction drawings and technical submittal documents laid out for review.

Why Elbaz

What we will actually
put our name to

  • Licensed general contractor

    Licensed, bonded and insured · CBC1265280.

  • Jurisdiction established first

    HVHZ or statewide framework confirmed before any product is specified.

  • Pressures by zone

    Corner and edge zones calculated separately rather than one building-wide figure.

  • Approval currency verified

    Expired and superseded approvals caught before submission, not at review.

  • Anchorage taken from the document

    Fastener, spacing and embedment as specified, not as convenient.

  • Corrections handled here

    We answer the plans examiner; you do not.

Every claim in this column is something we can evidence. We have deliberately left out award badges, membership logos and project counts.

Reviews

I highly recommend them for home improvement. They renovated my master bathroom and a few upgrades for other guest bathrooms. They are very professional, courteous and transparent. They are great at communicating and finding ways to streamline the work. Sean has impeccable project management and customer relationship management skills. Very pleased with the work!

Omri B

Genuine Google reviews of Elbaz Construction, shown as written. None of these reviewers describes a product-compliance permitting engagement specifically, so none is presented as one.

Read them on Google

Redid my whole bathroom and kitchen. Great service - Great quality - very quick - very professional !! Highly recommended!

Adir Davidov

They are amazing! Very professional. Met my exact requests with so much patience and knowledge. They renovated my whole house and the whole process was such a breeze. I highly recommend them!

Lee Morali

We hired them to renovate our investment property and they provided exceptional quality service for an affordable price!

Shir Partush

Amazing experience with the entire company! They did a great job in my house for some work that needed to be completed, and I am extremely happy with the result. Super professional & great service. I highly recommend Elbaz Construction.

Mia Zafrani

After I've been Looking for a good company to renovate my house , I found those guys! These people are super professional super honest super Fast !! Don't hesitate to Rent their service! They are number one!!

carmit cohen

Start here

Tell us about the openings

What helps on the first call

The property address, how many openings, what products are being considered, and whether construction drawings already exist.

What happens next

We confirm which framework applies and verify that the products proposed are actually approved for the pressures involved.

What you will not get

A submittal built on an approval nobody checked the date on.

Preferred contact method

We use your details only to respond to this enquiry. No lists, no resale.

Thanks — that came through.

Your details are with the Elbaz Construction team and we will come back to you, usually the same or next working day. If it is urgent, call (754) 236-0675.

Get the submittal right
the first time.

One opening schedule, verified approvals, an anchorage schedule taken from the documents, and corrections answered by us.

Cutaway of an impact-rated window showing the laminated interlayer and frame anchorage
